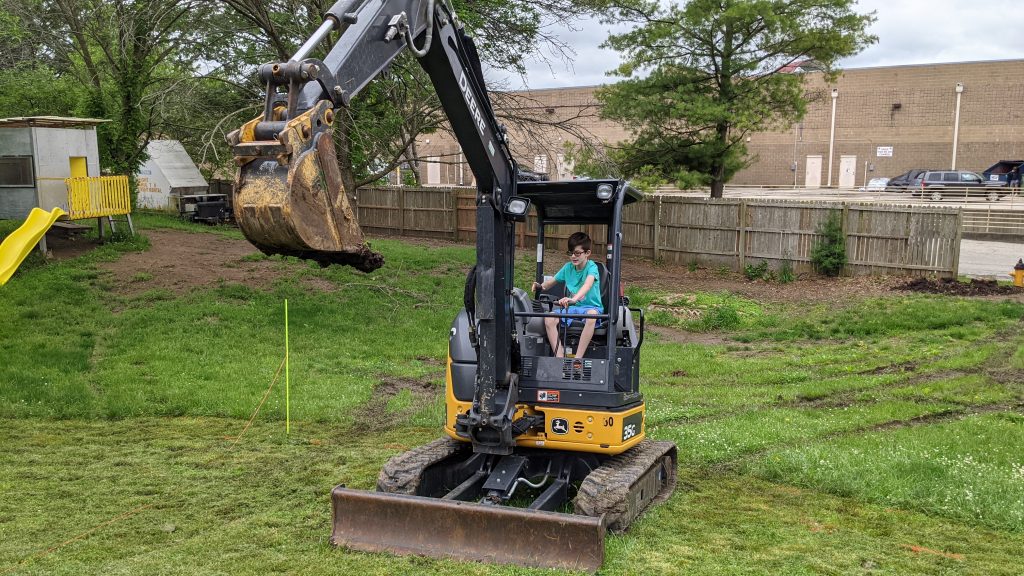

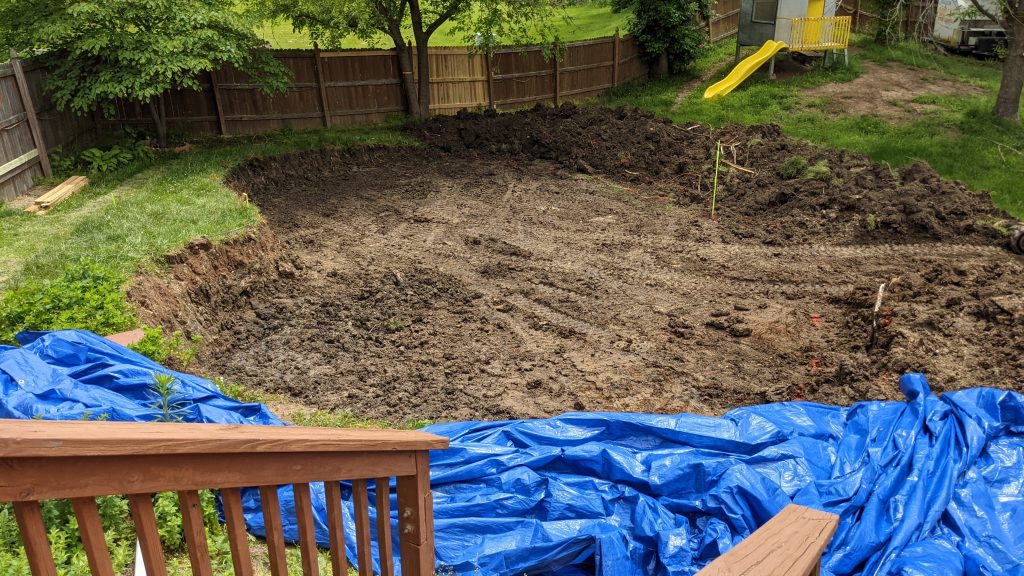

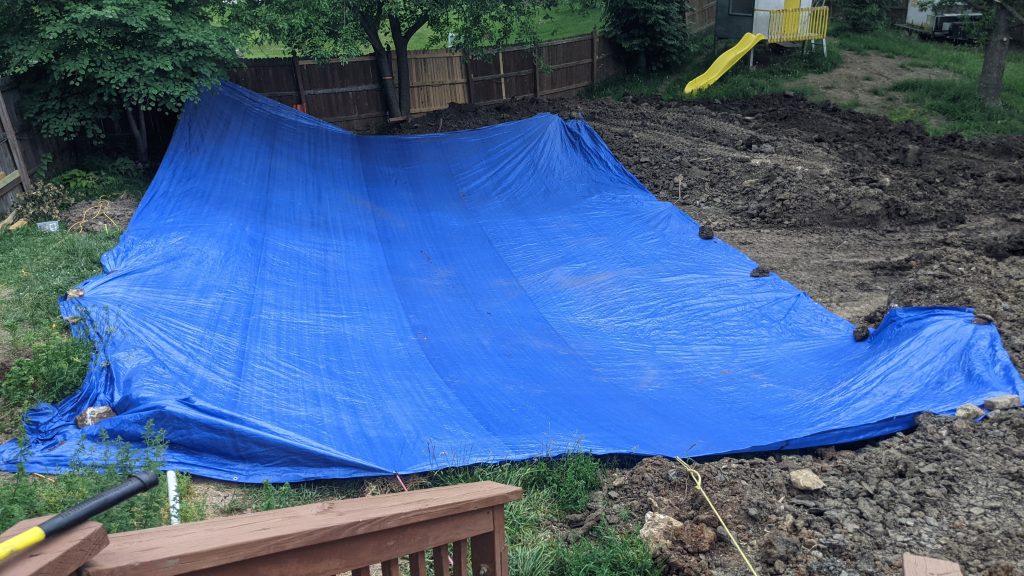

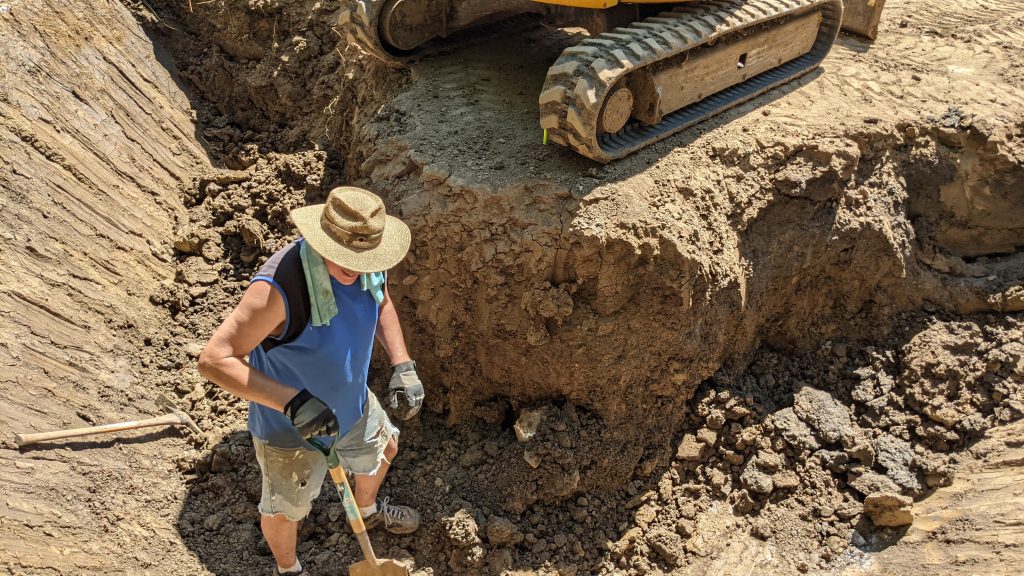

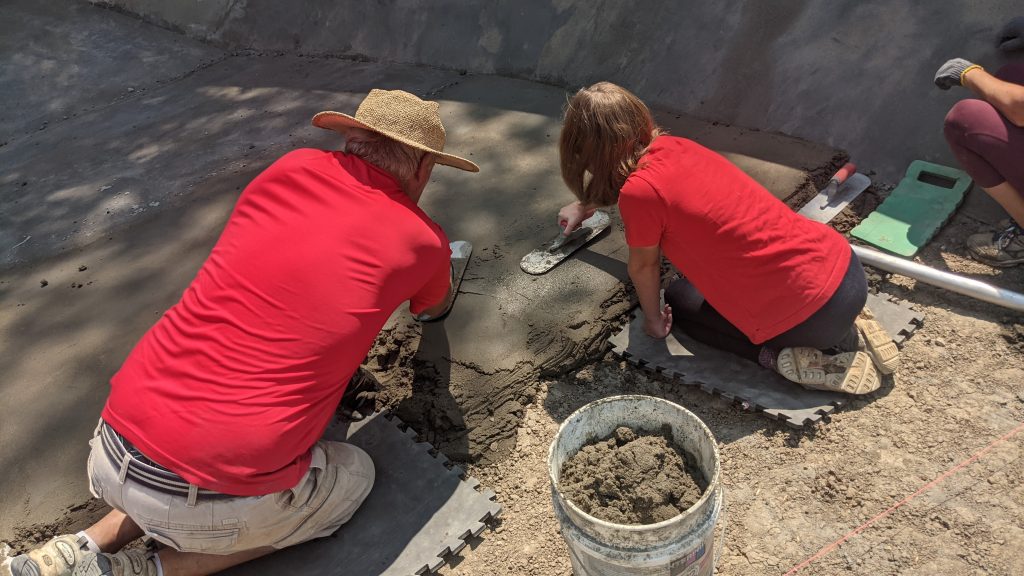

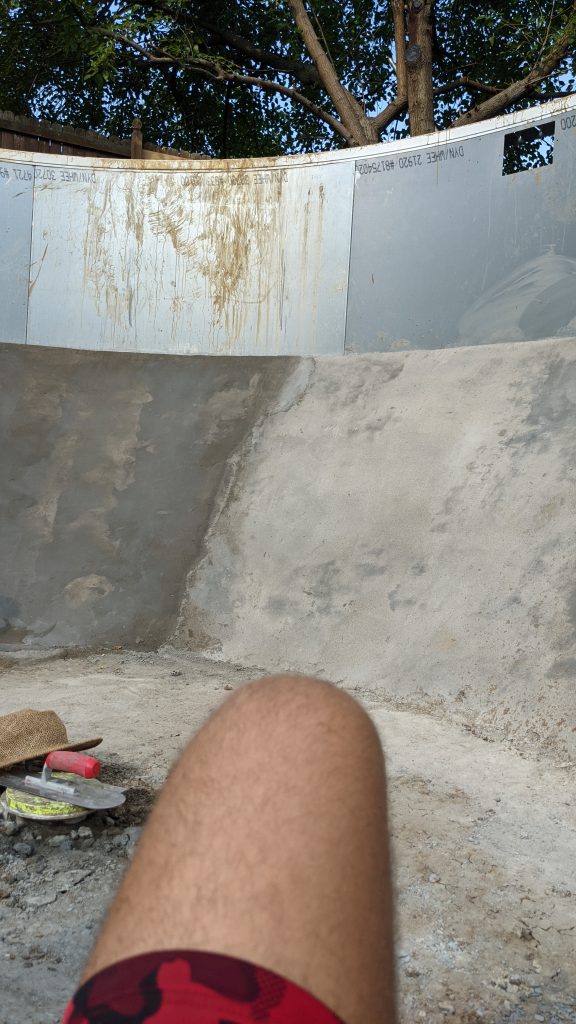

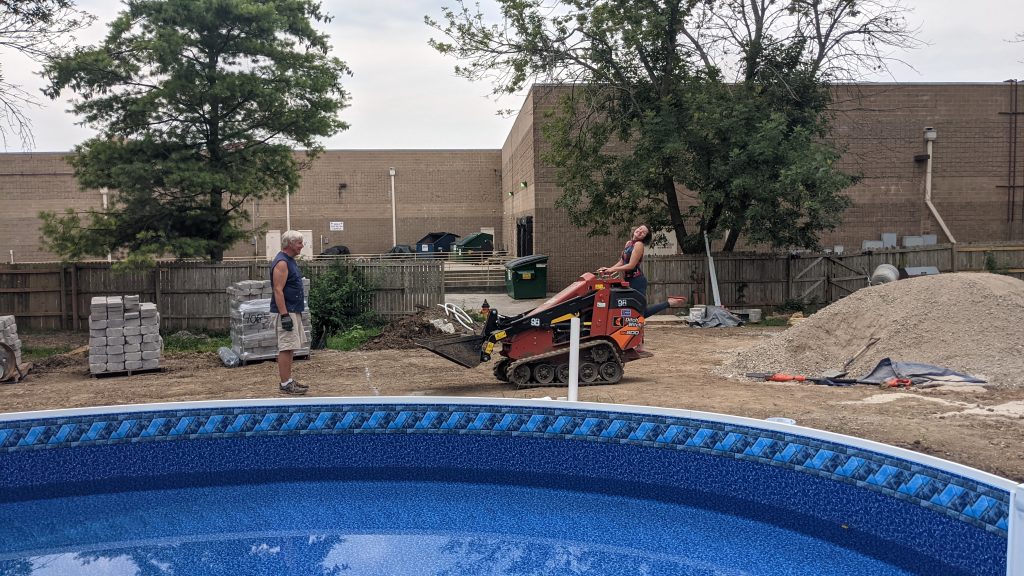

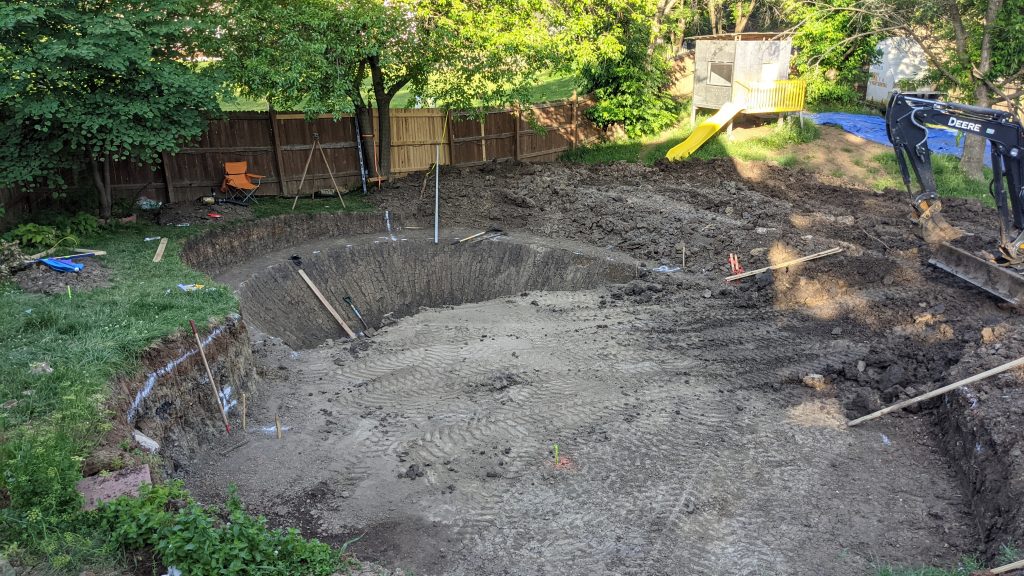

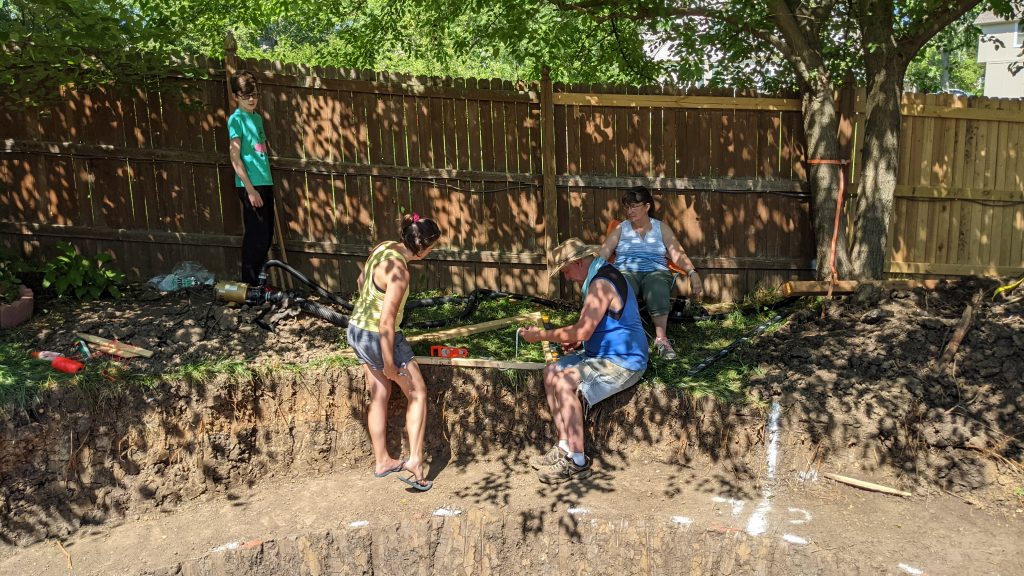

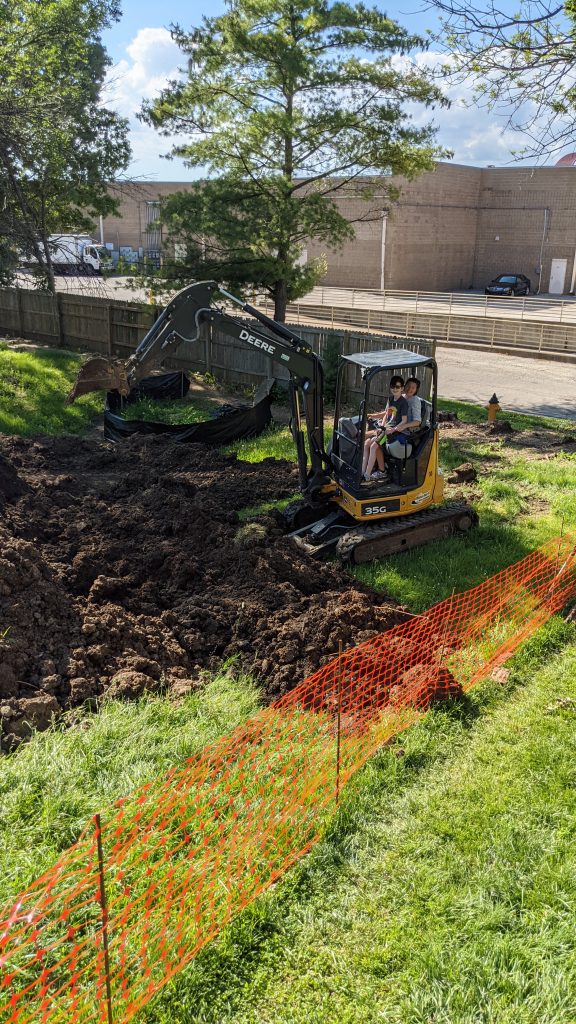

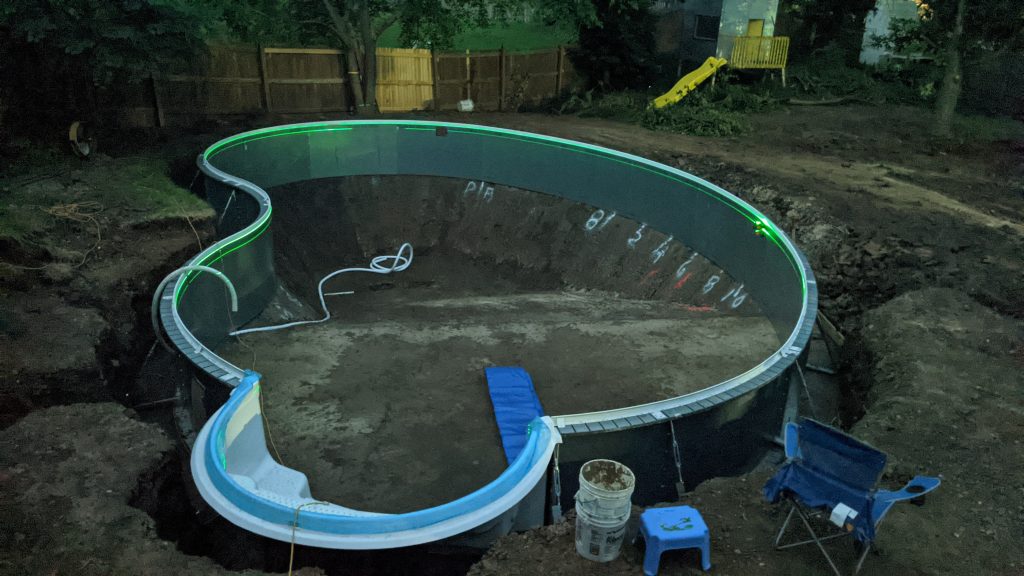

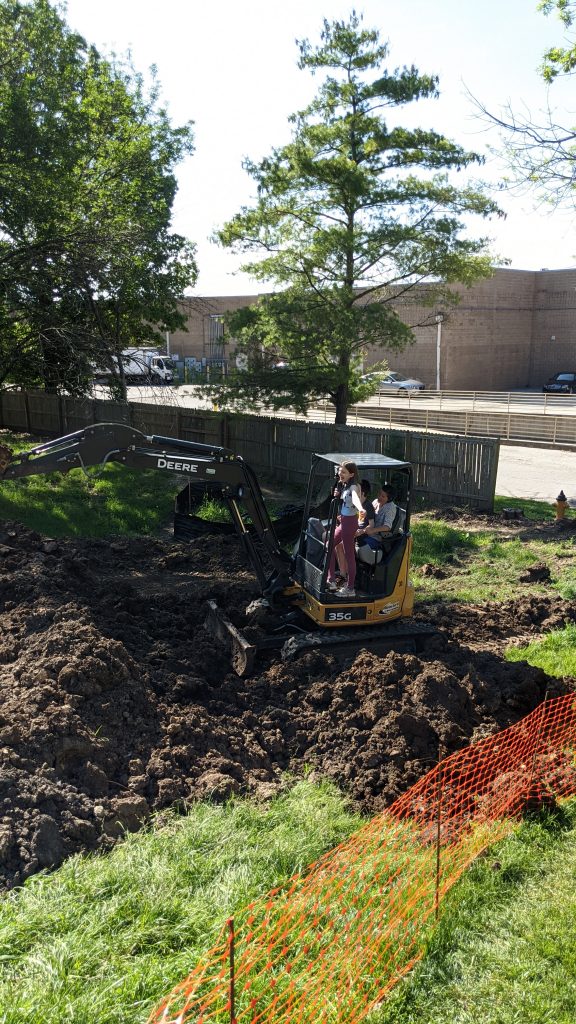

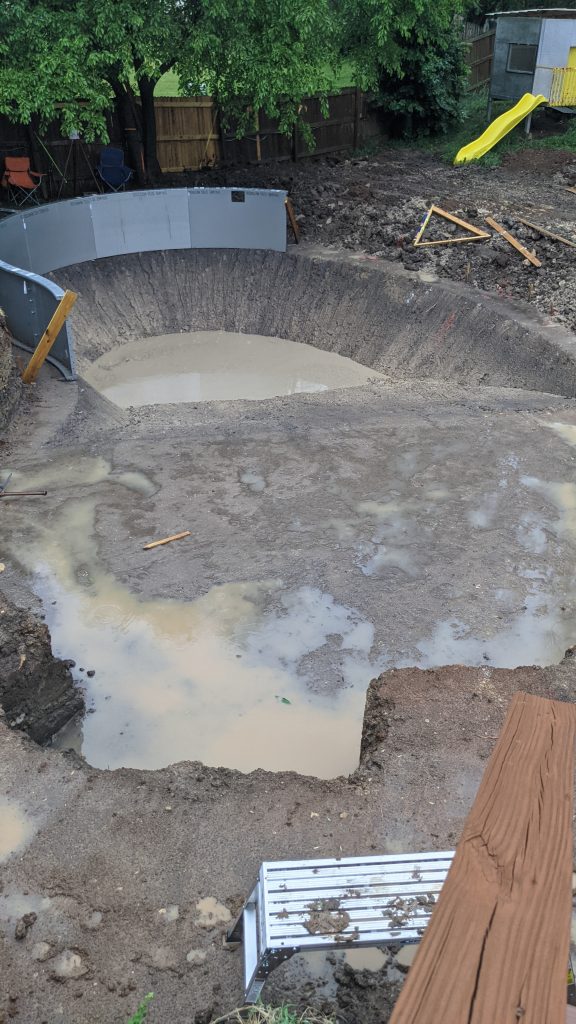

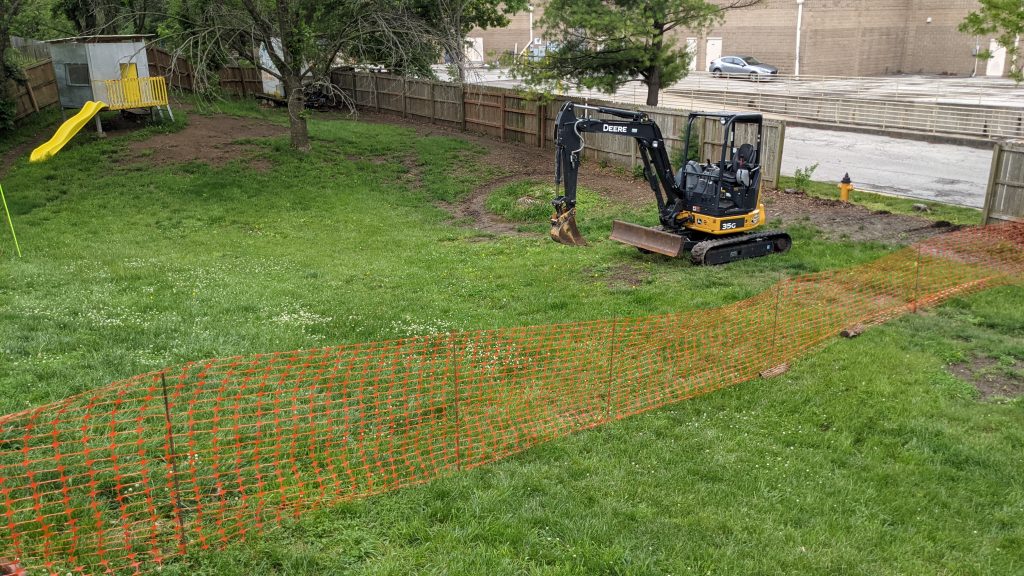

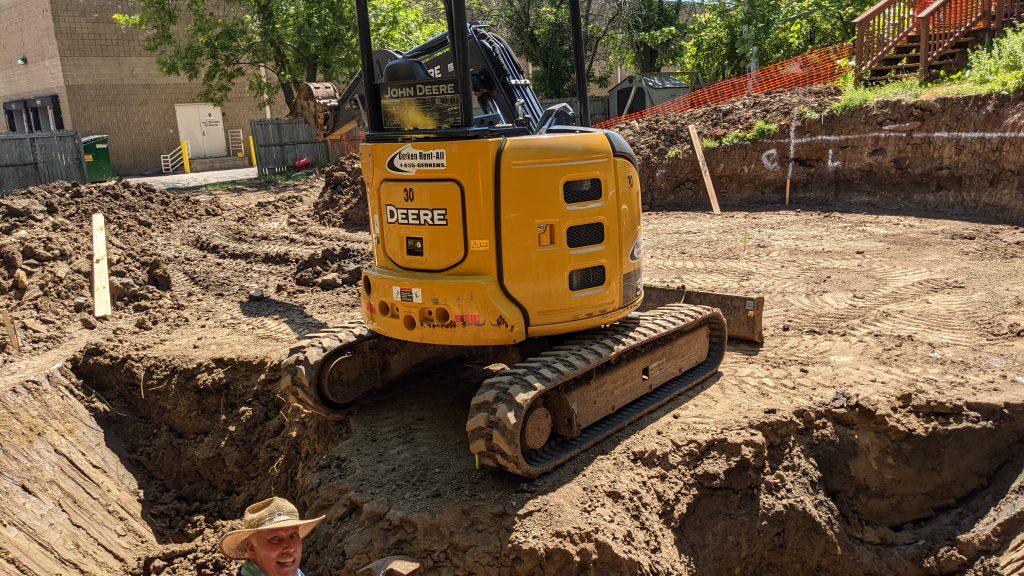

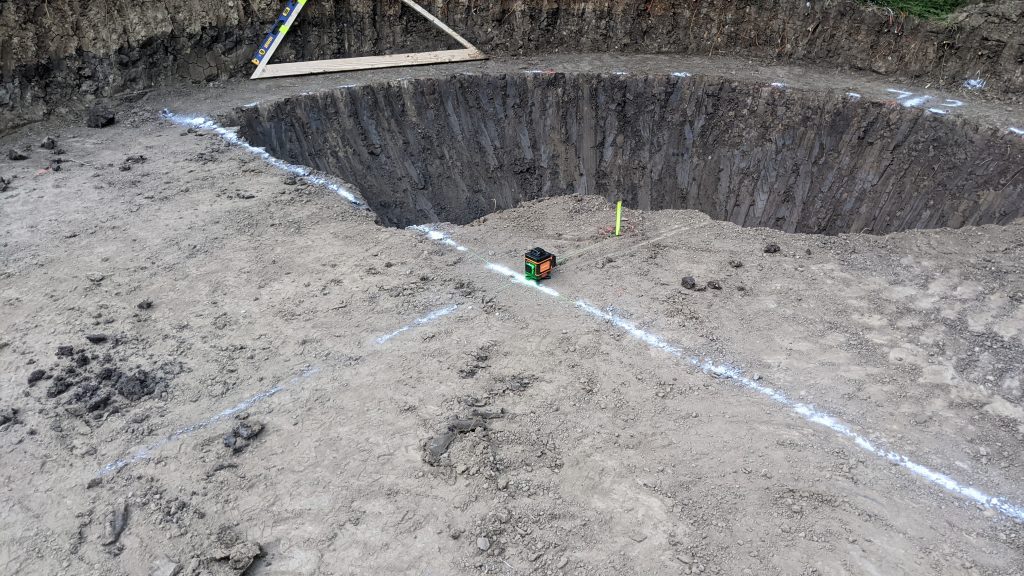

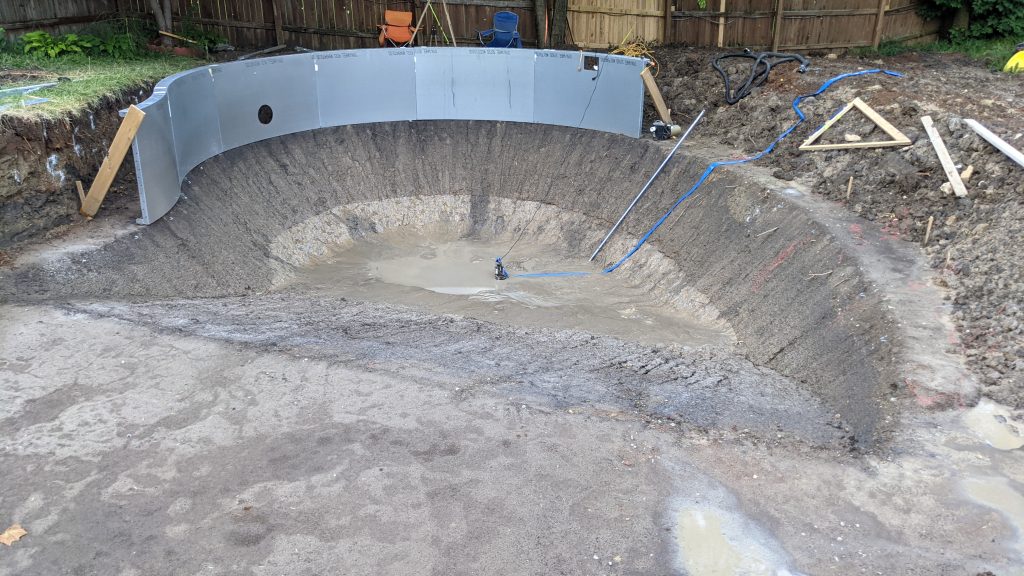

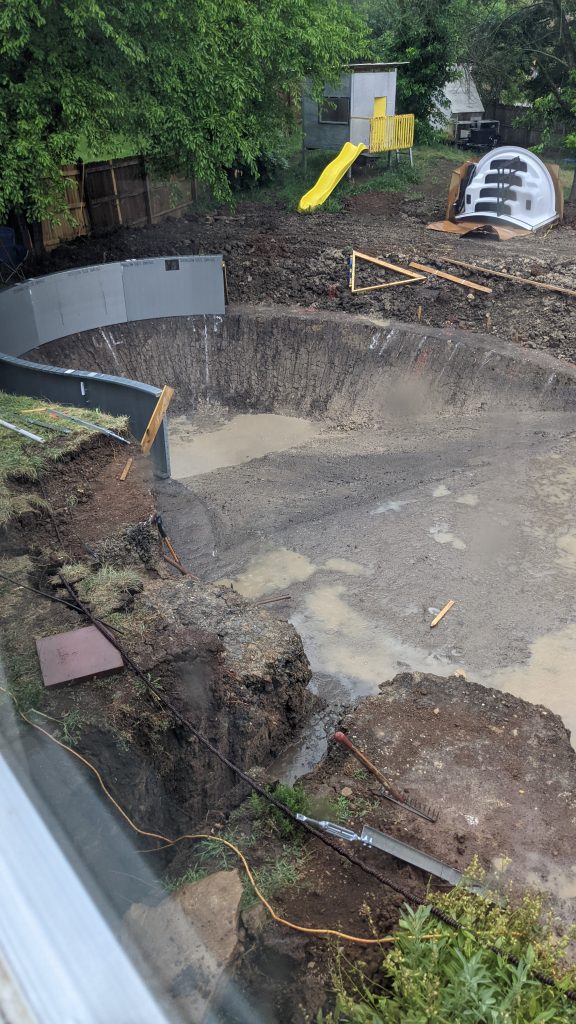

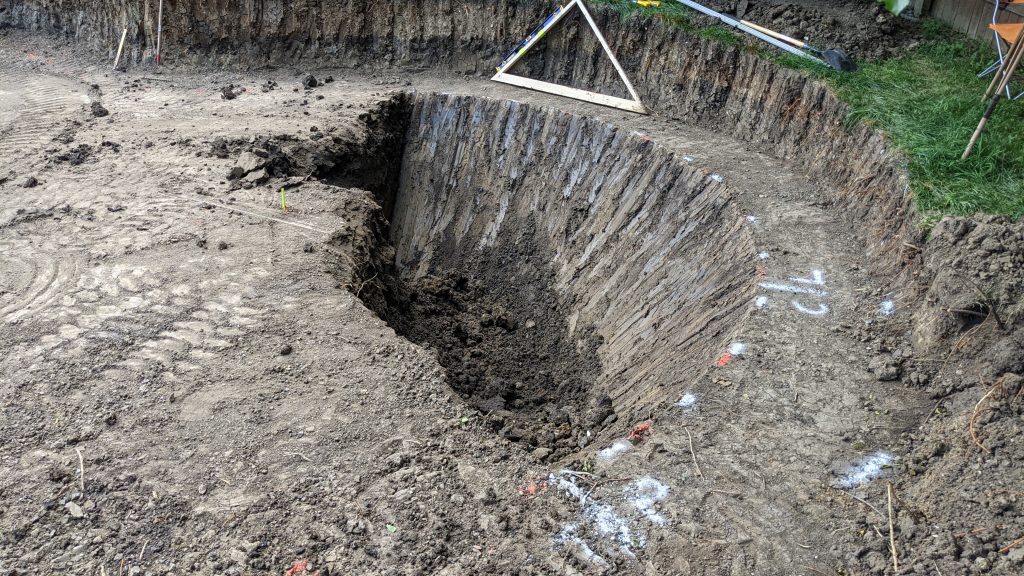

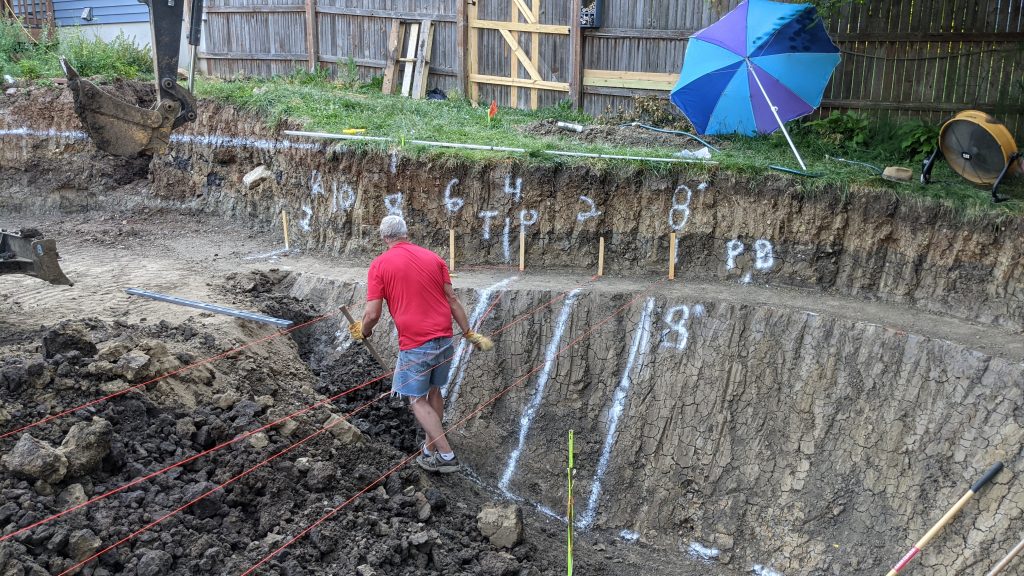

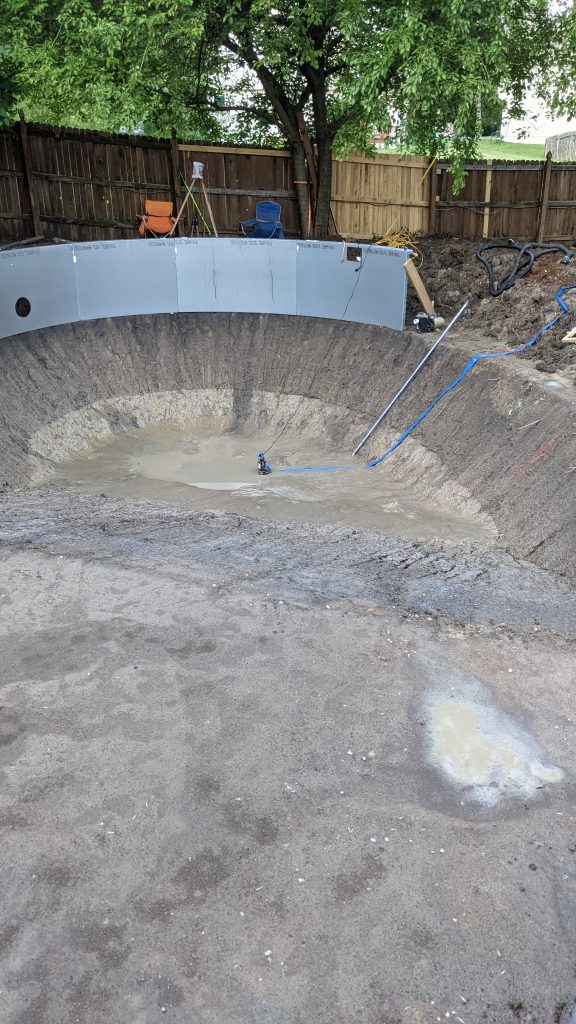

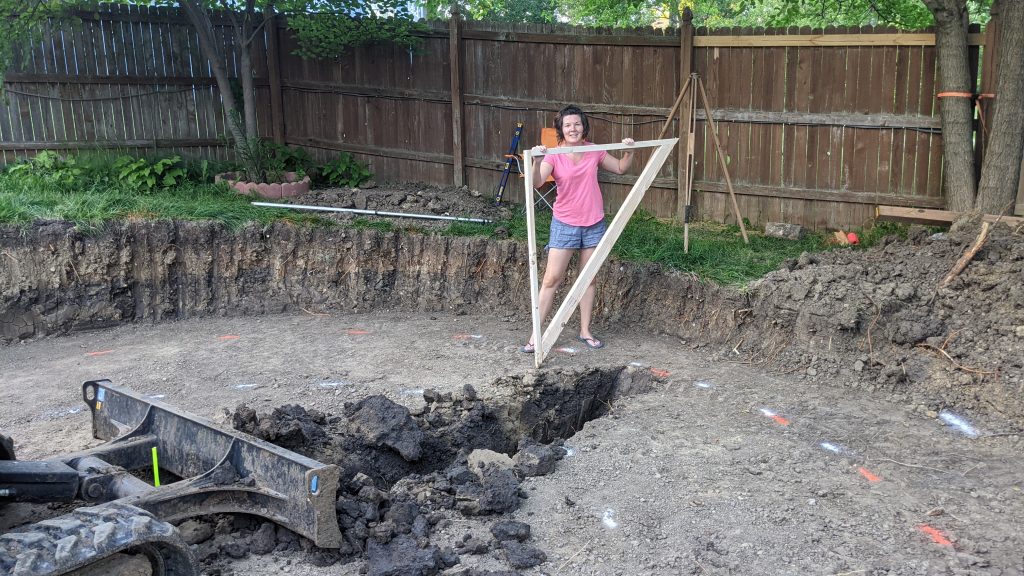

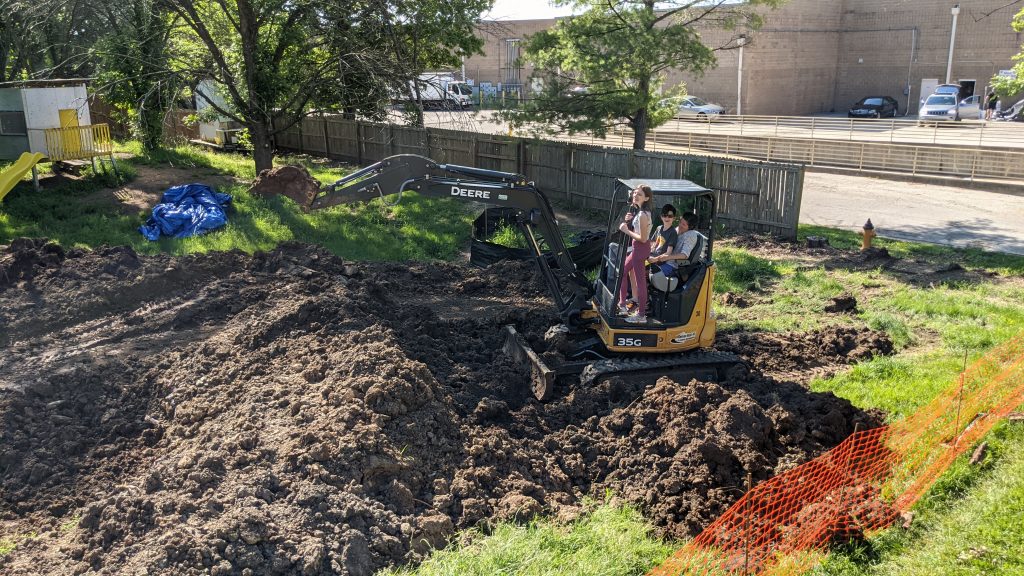

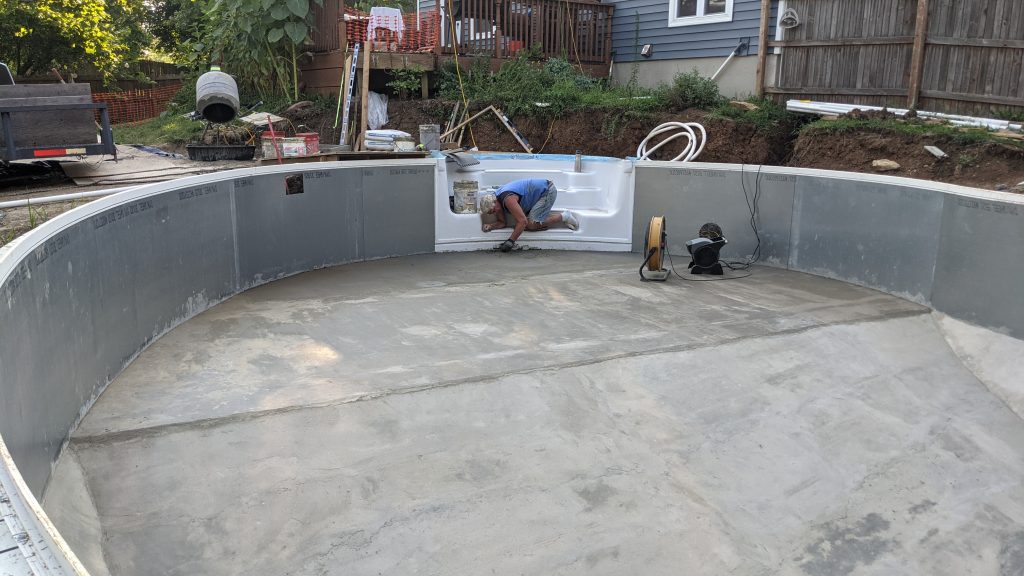

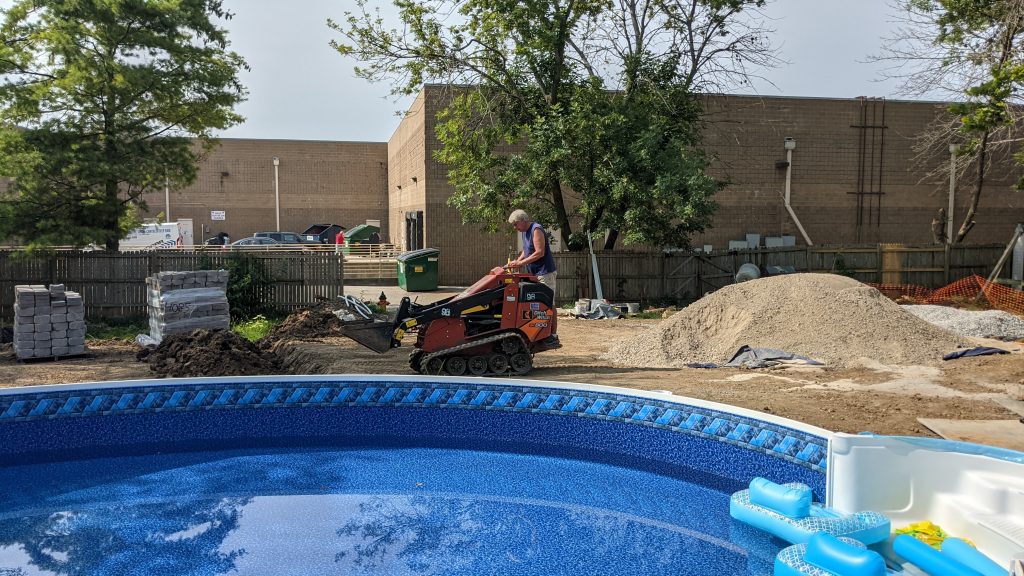

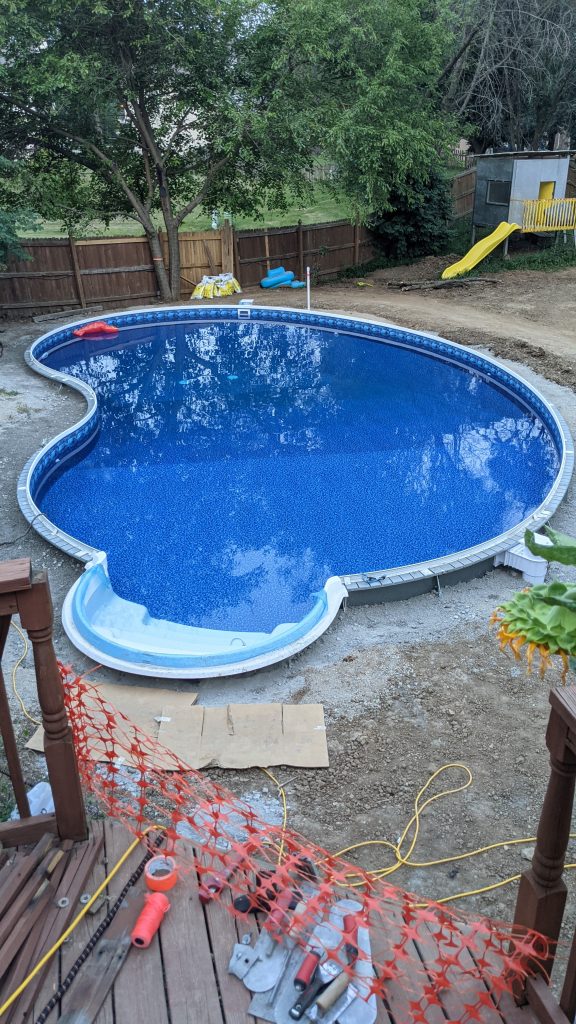

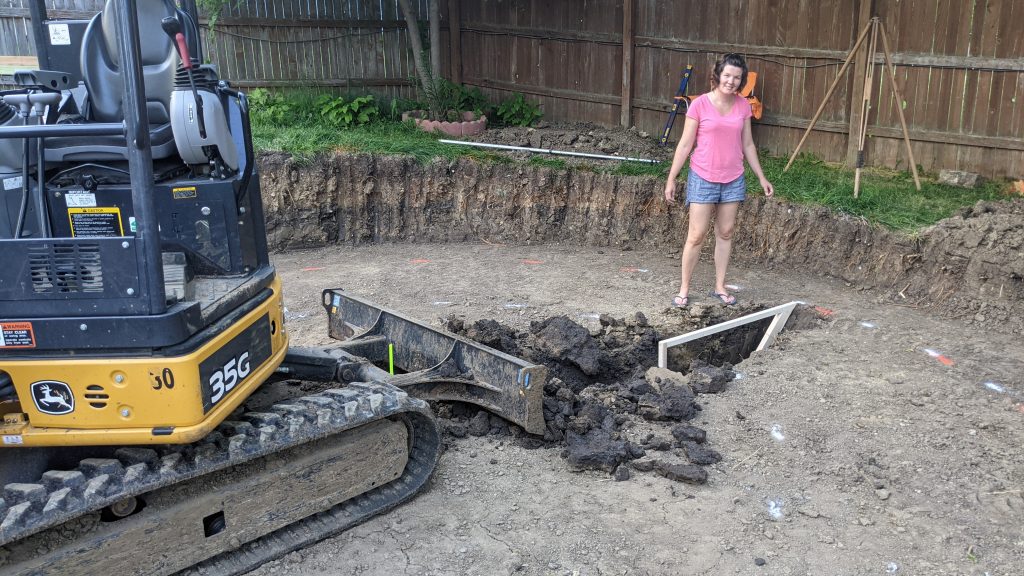

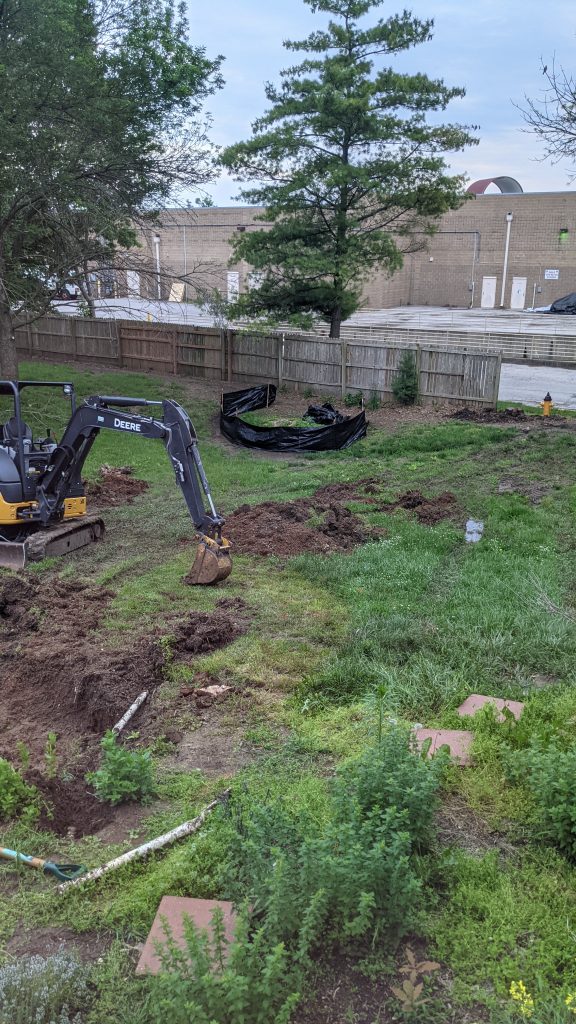

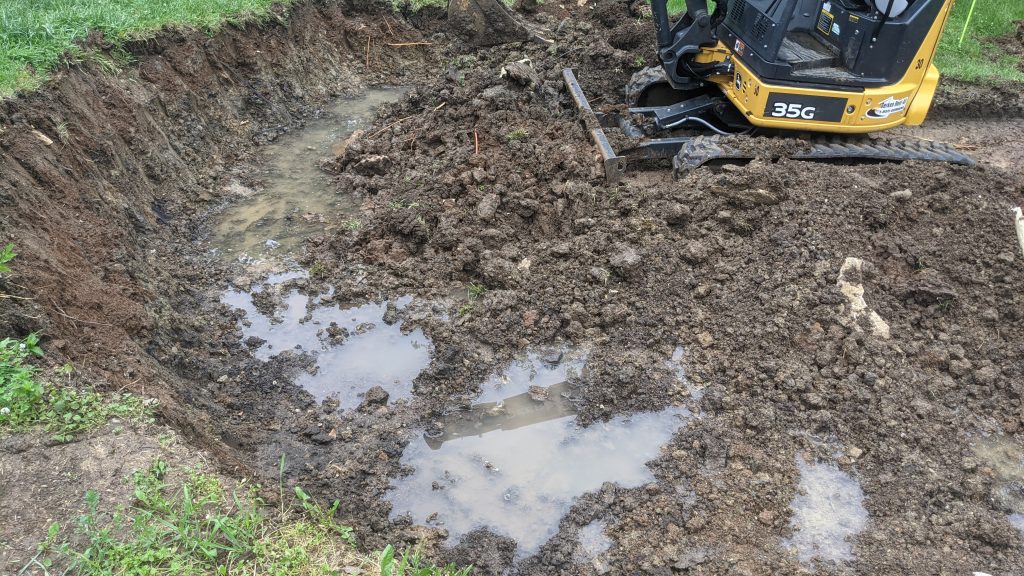

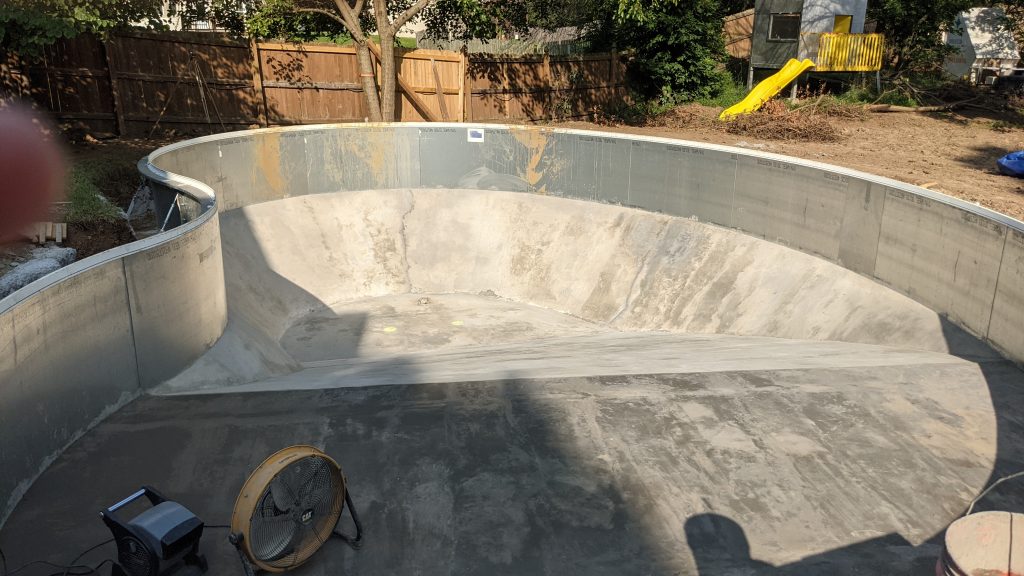

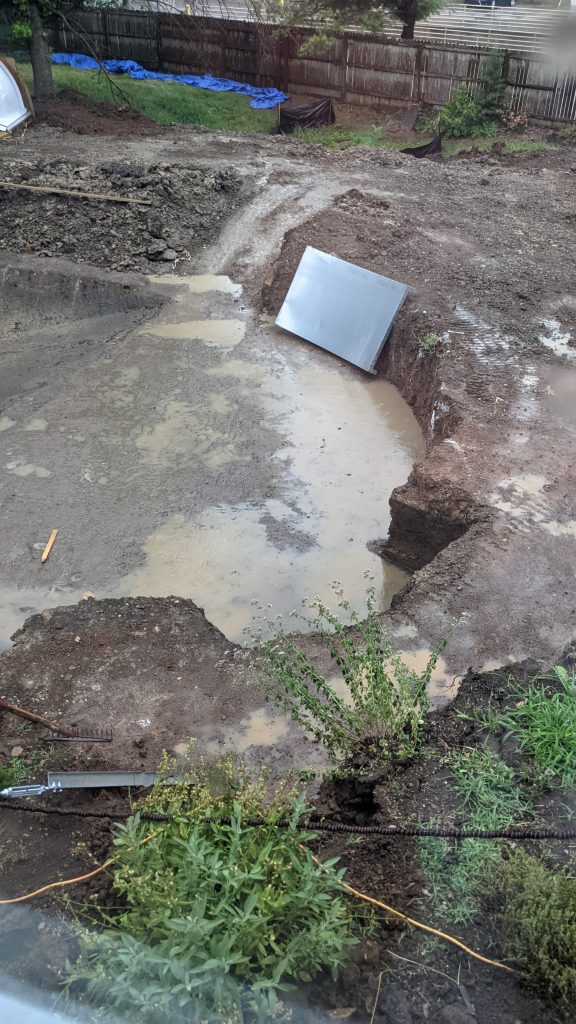

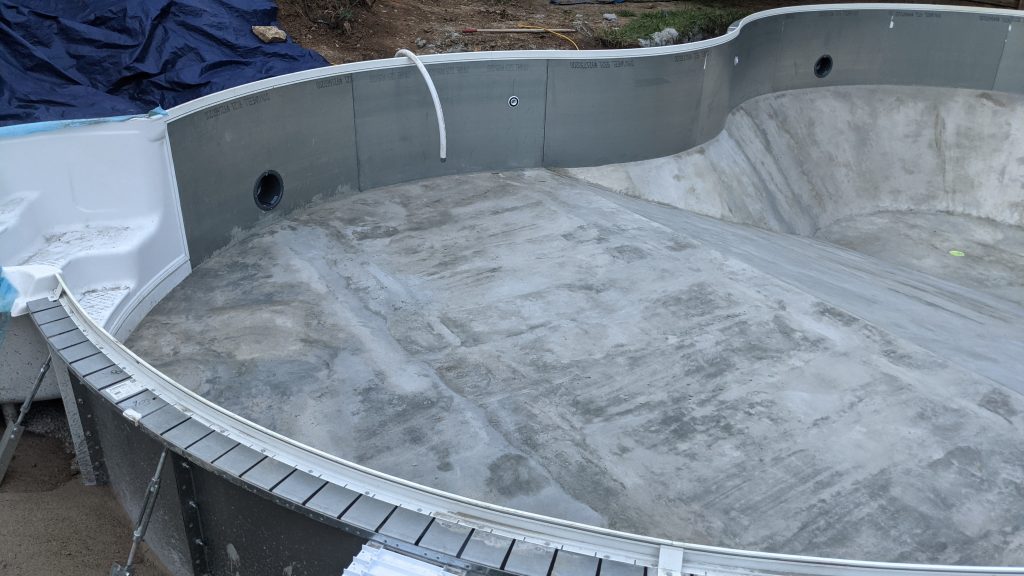

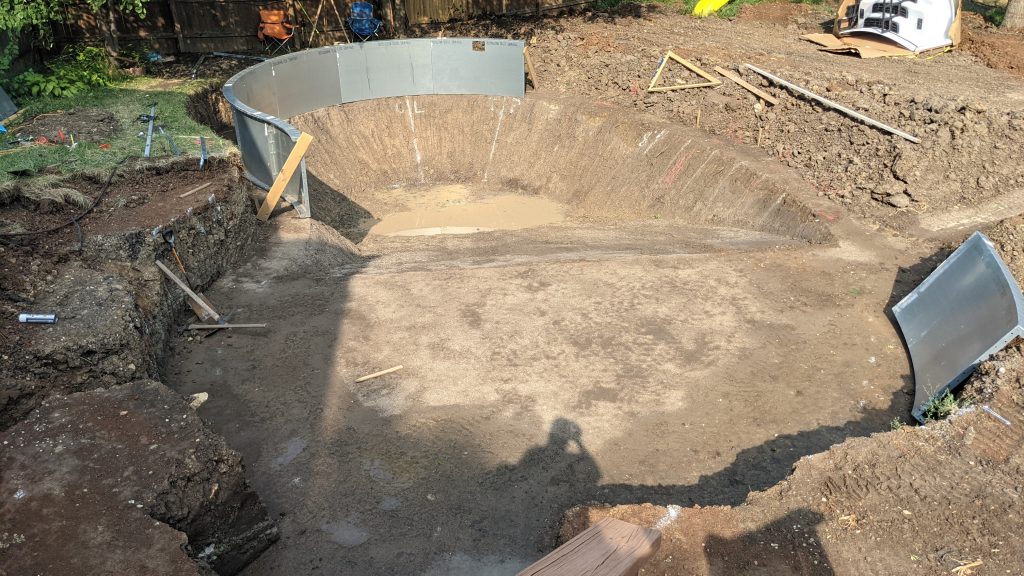

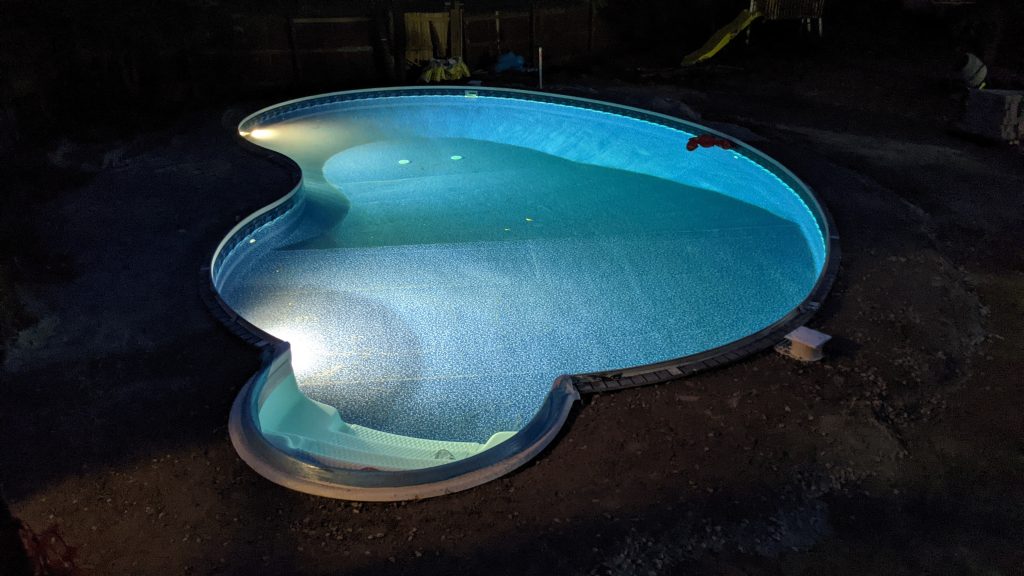

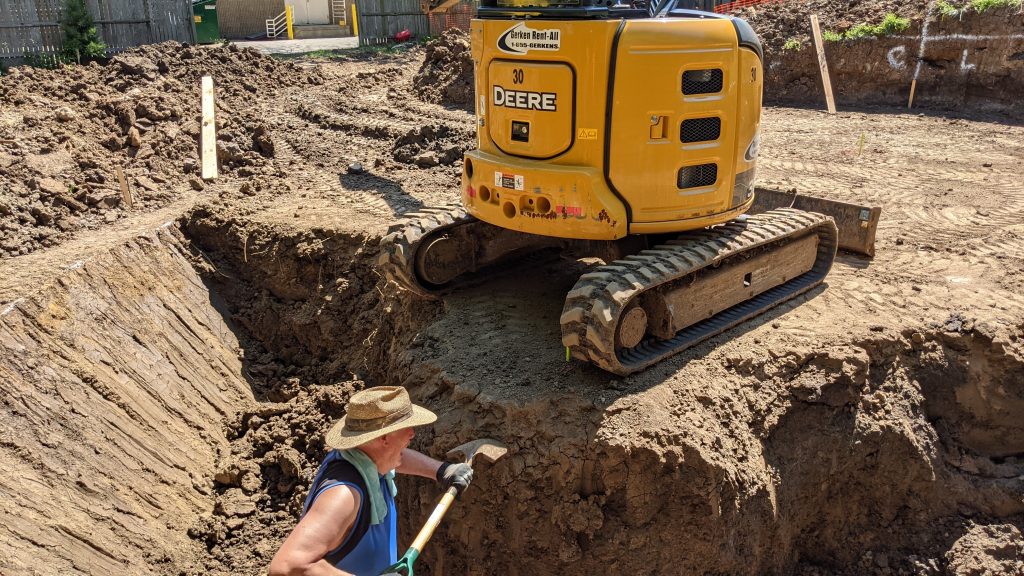

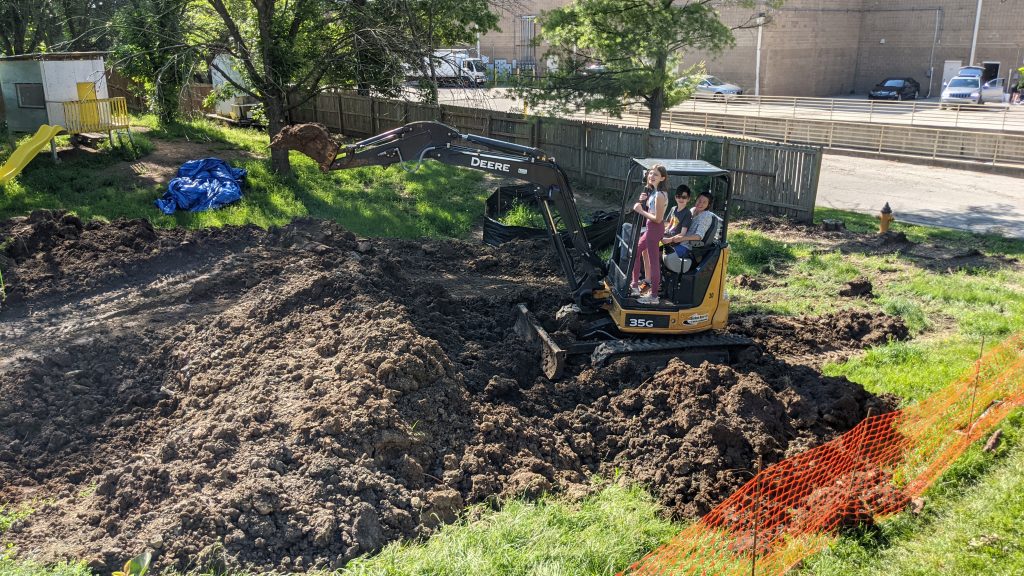

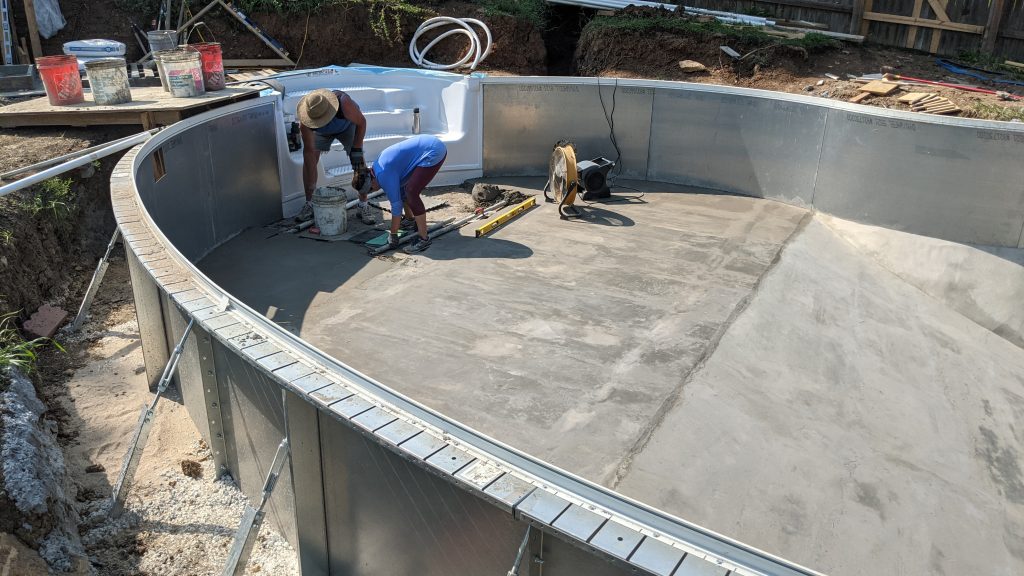

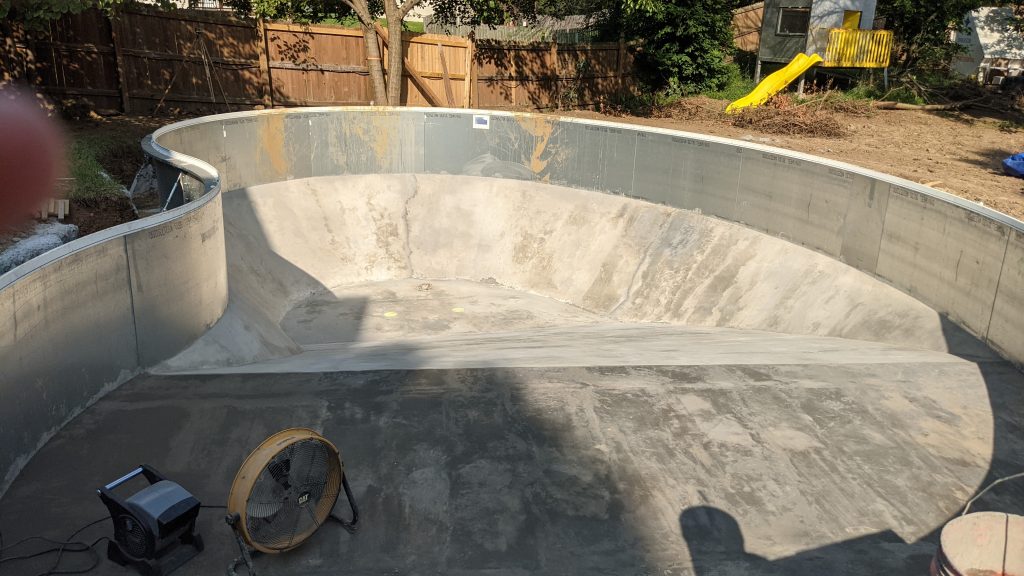

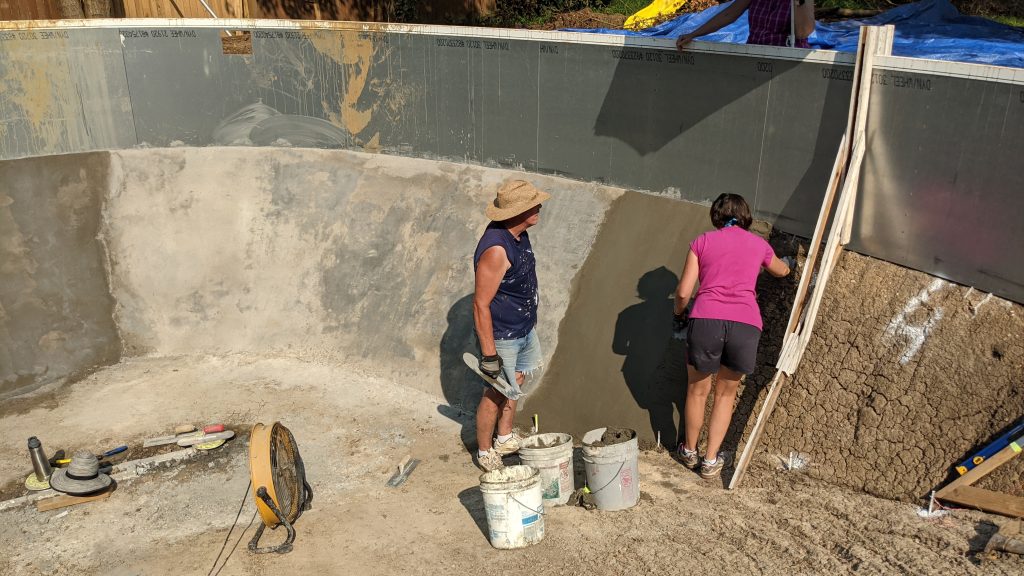

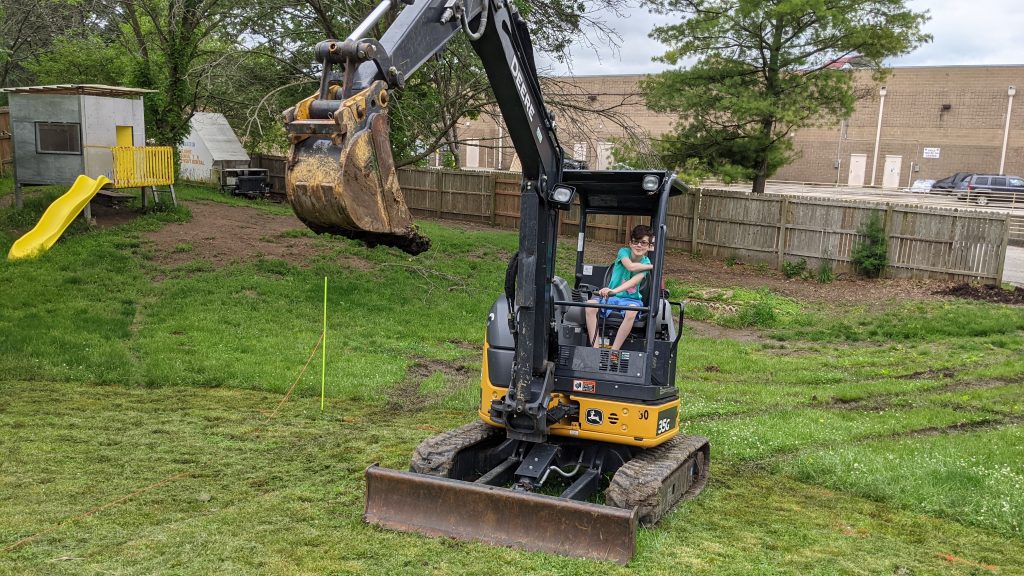

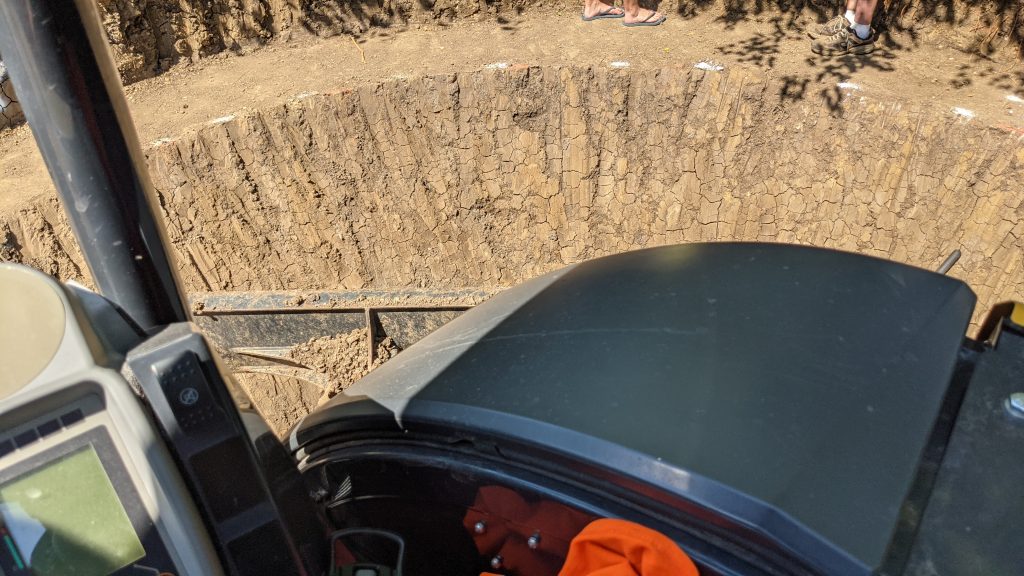

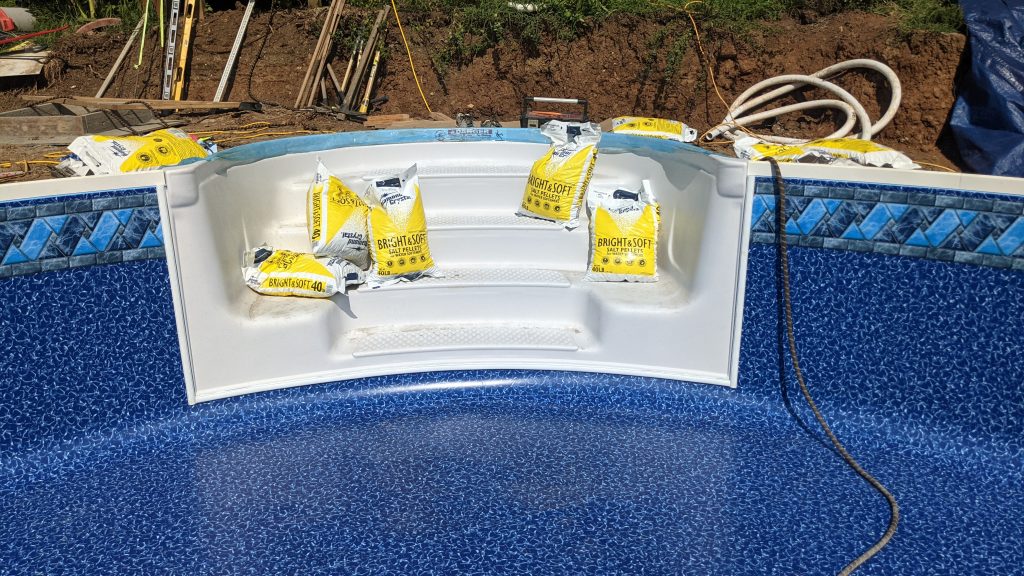

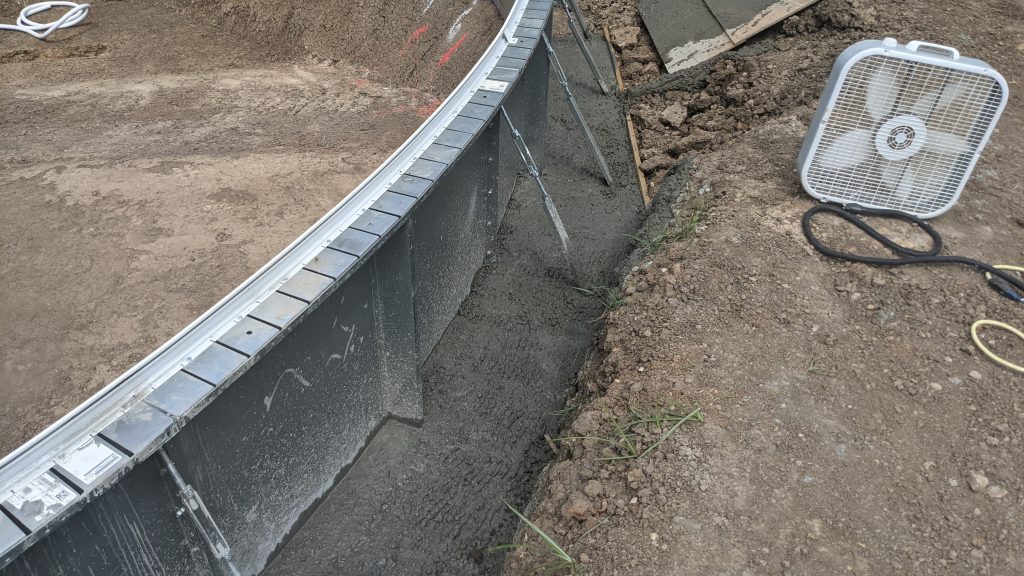

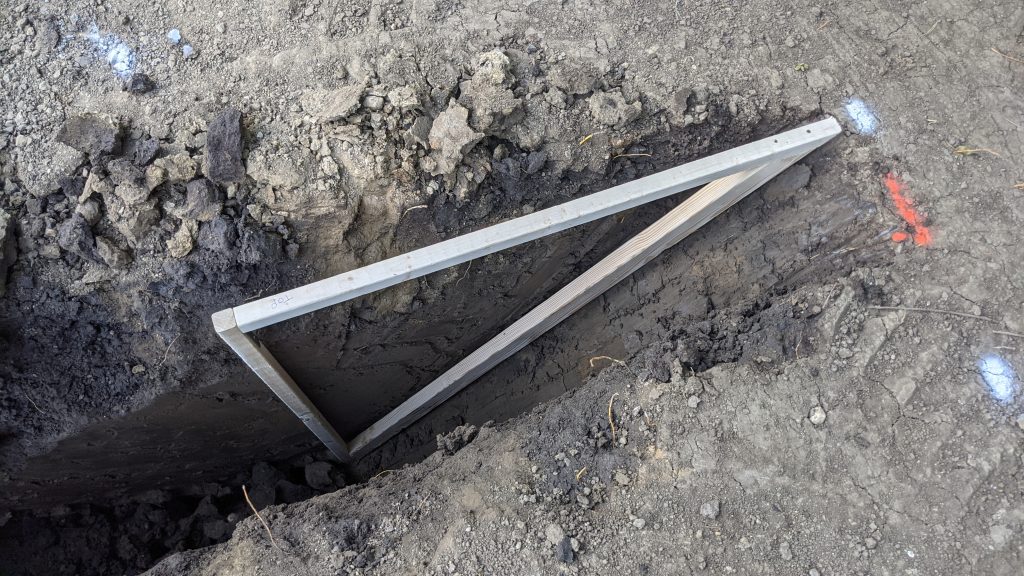

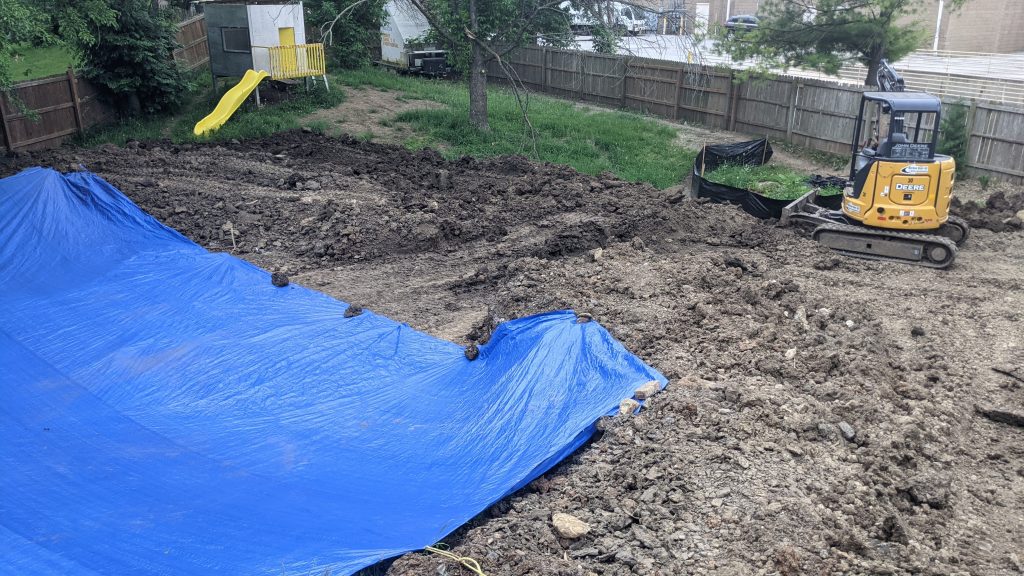

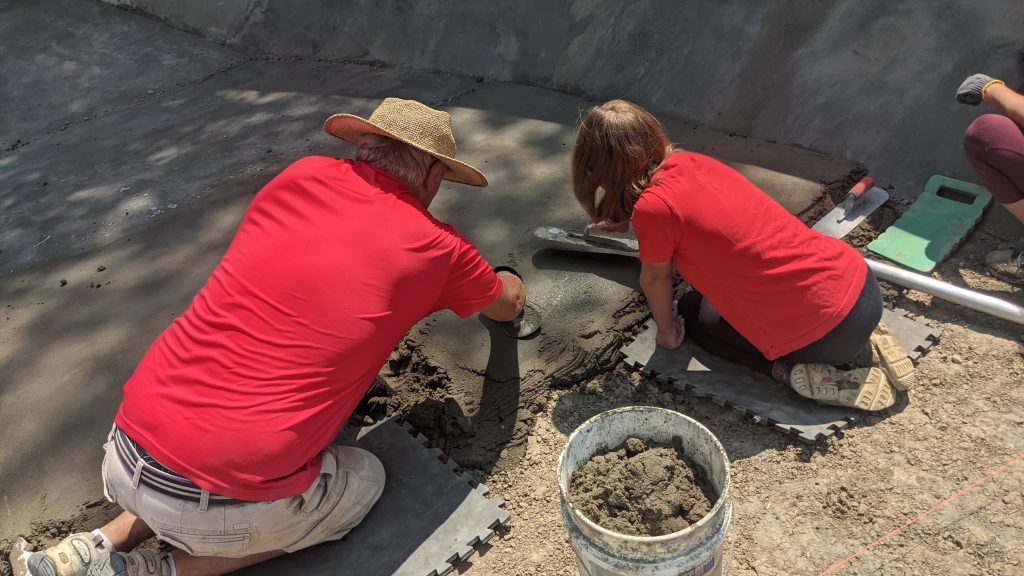

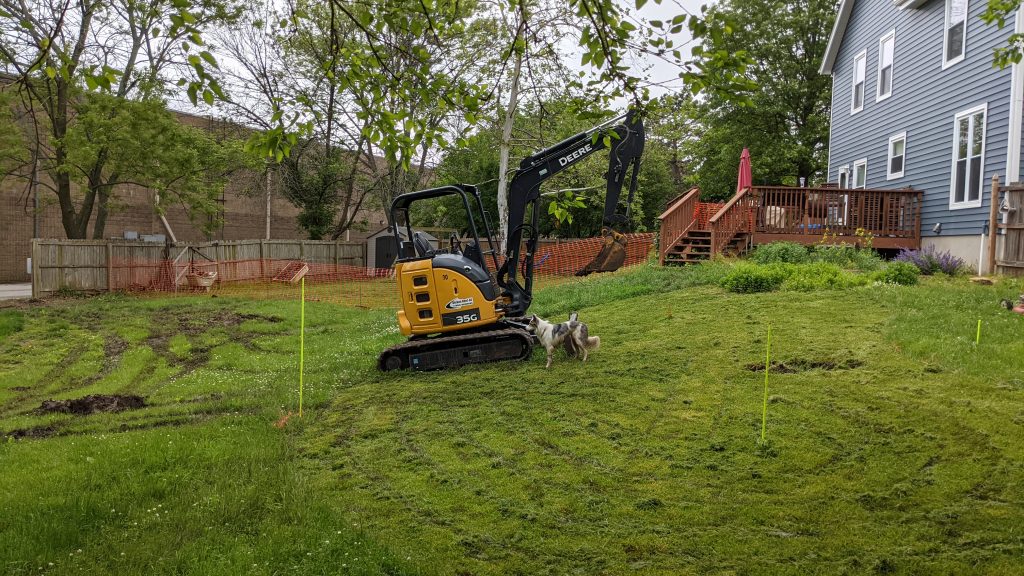

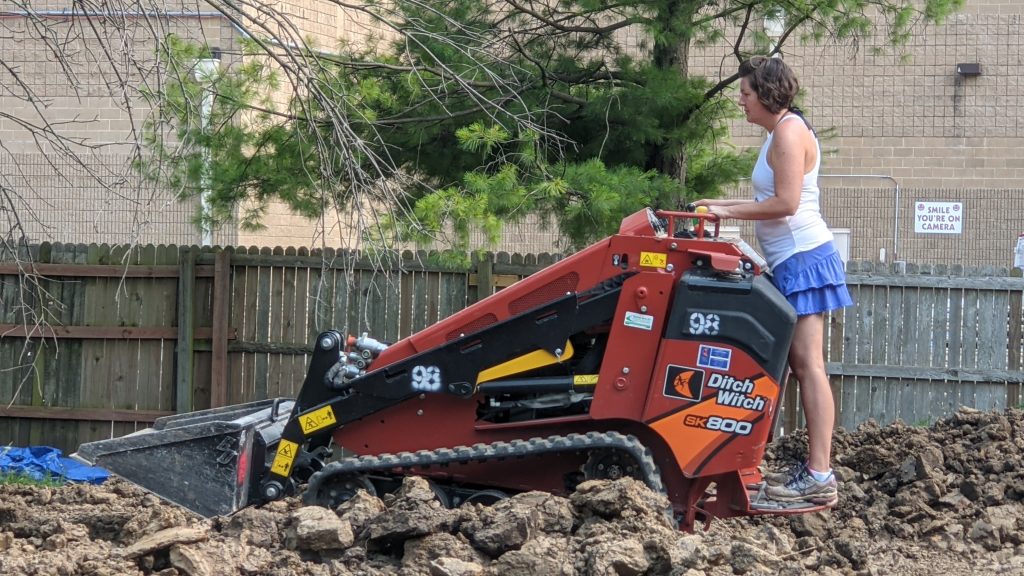

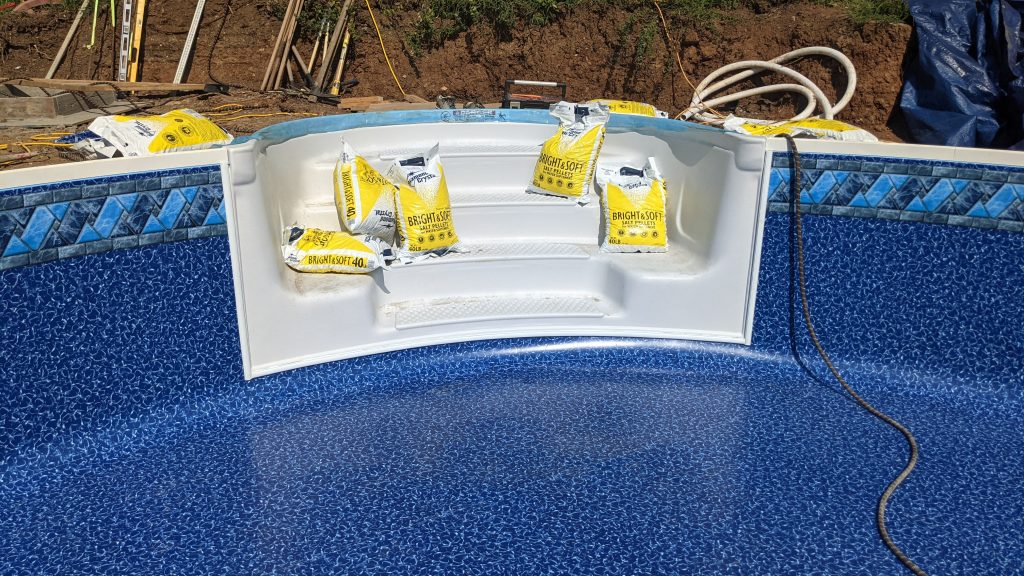

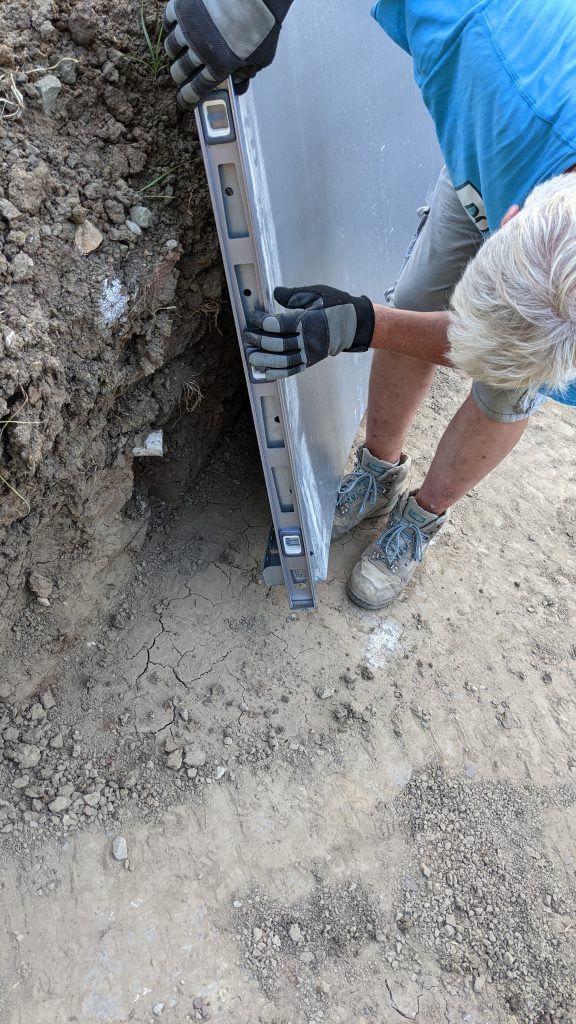

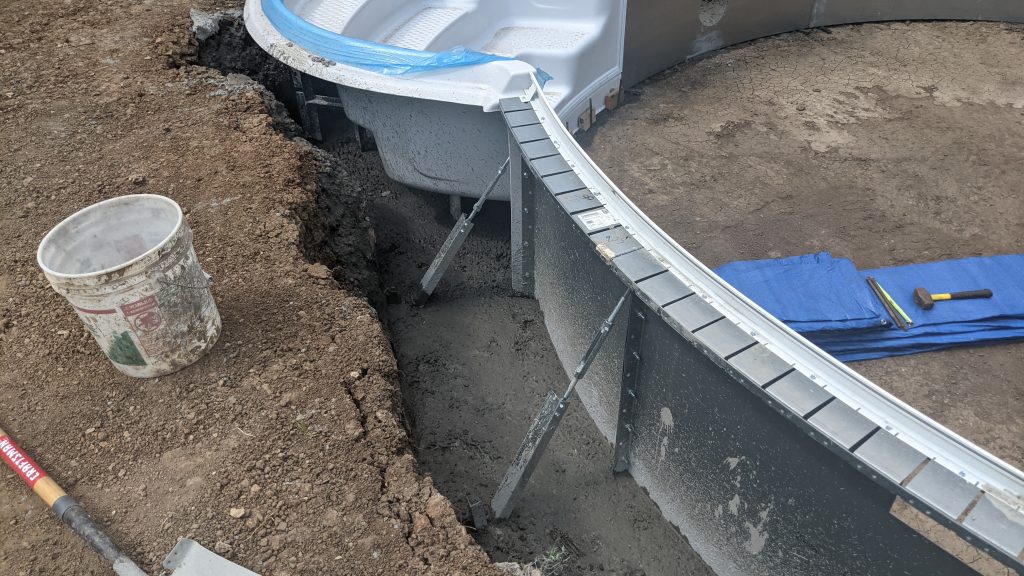

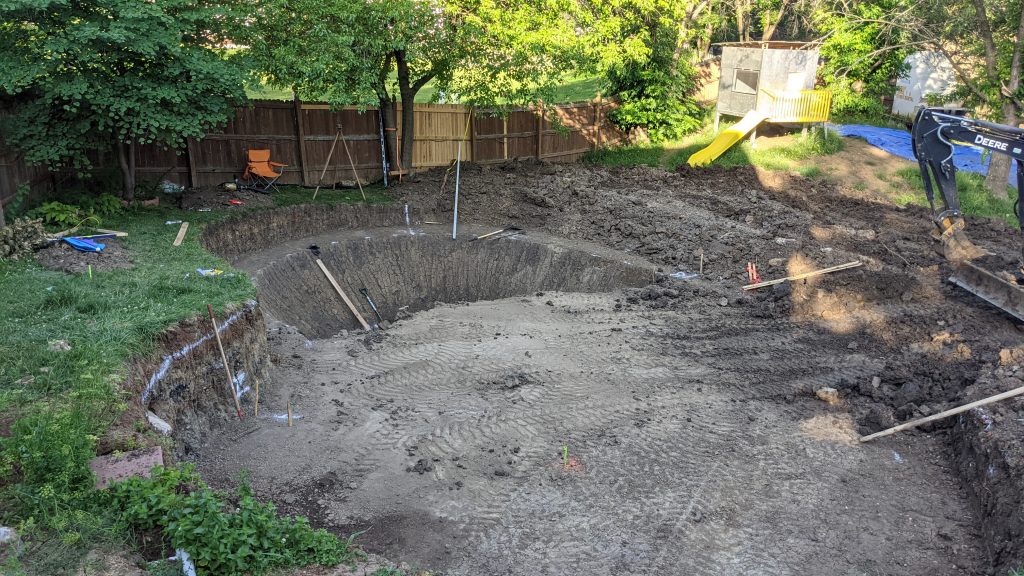

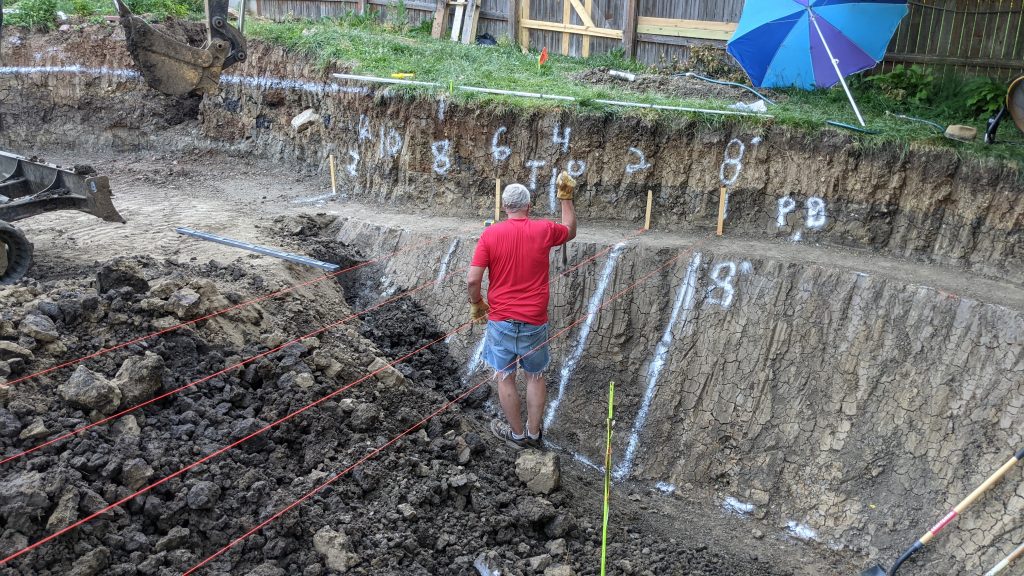

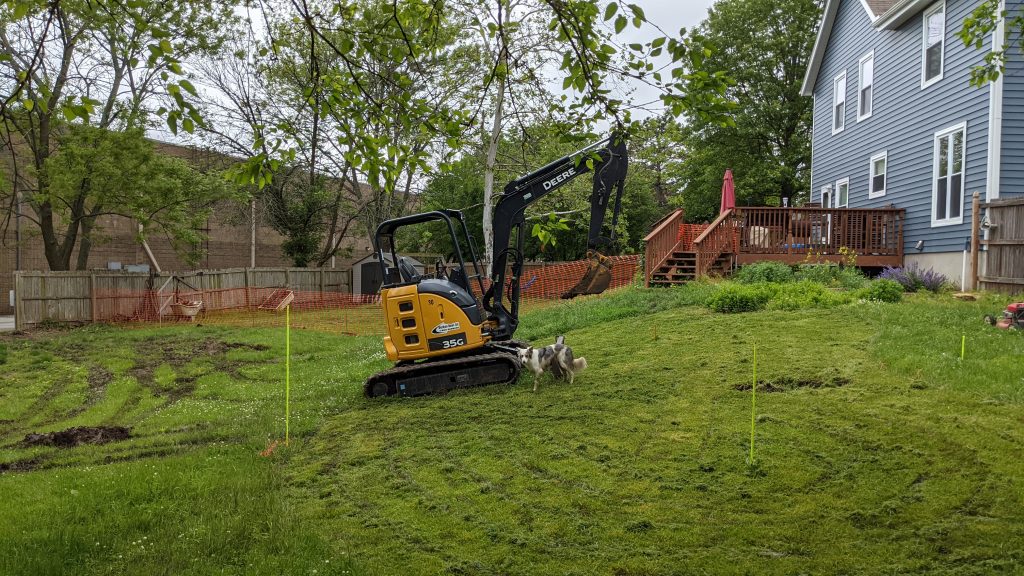

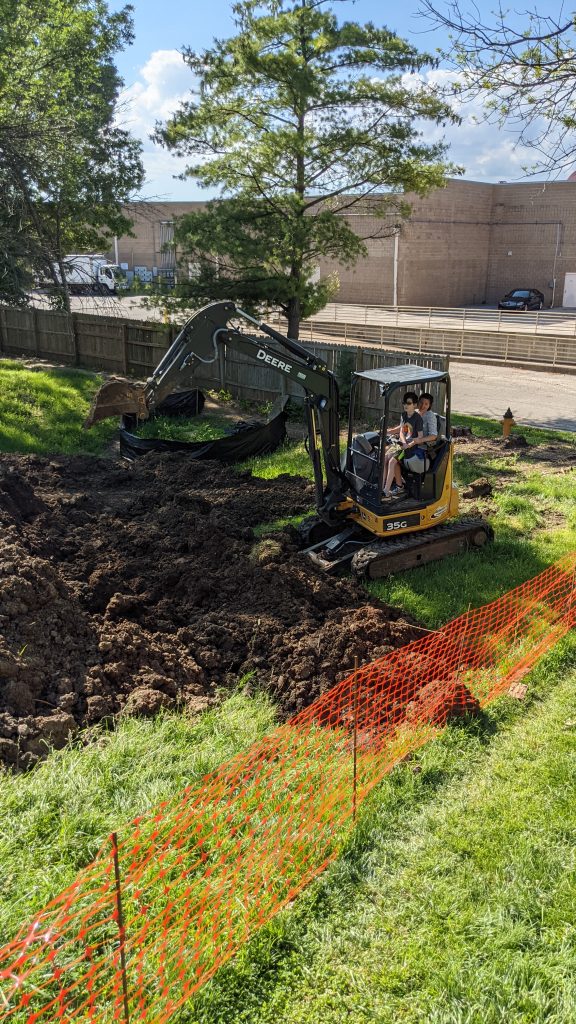

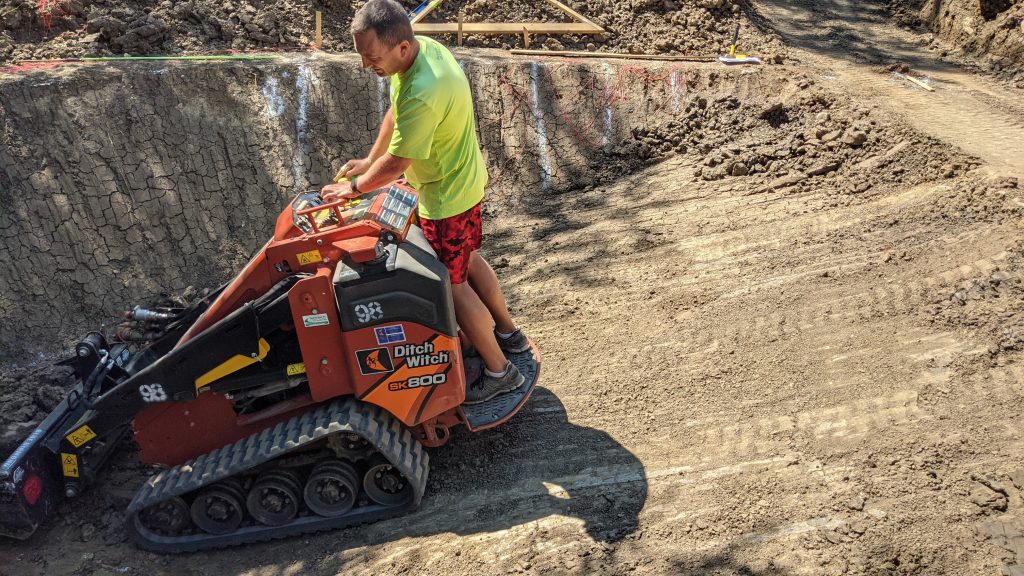

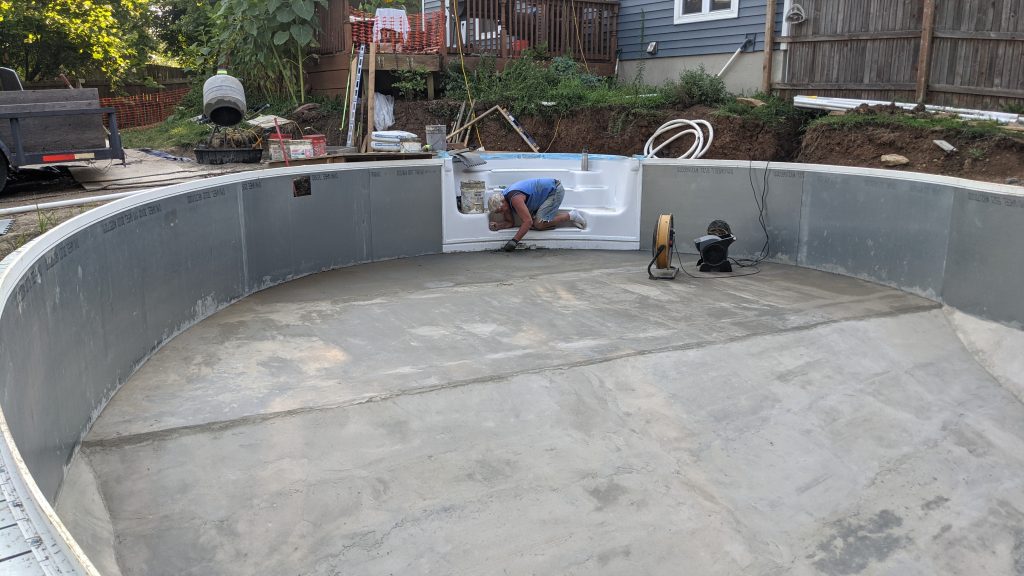

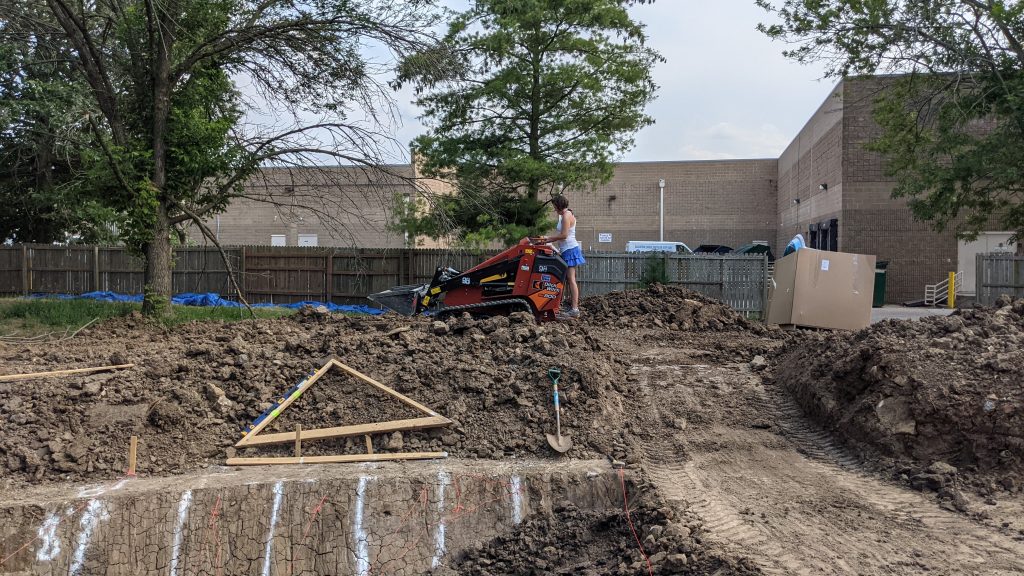

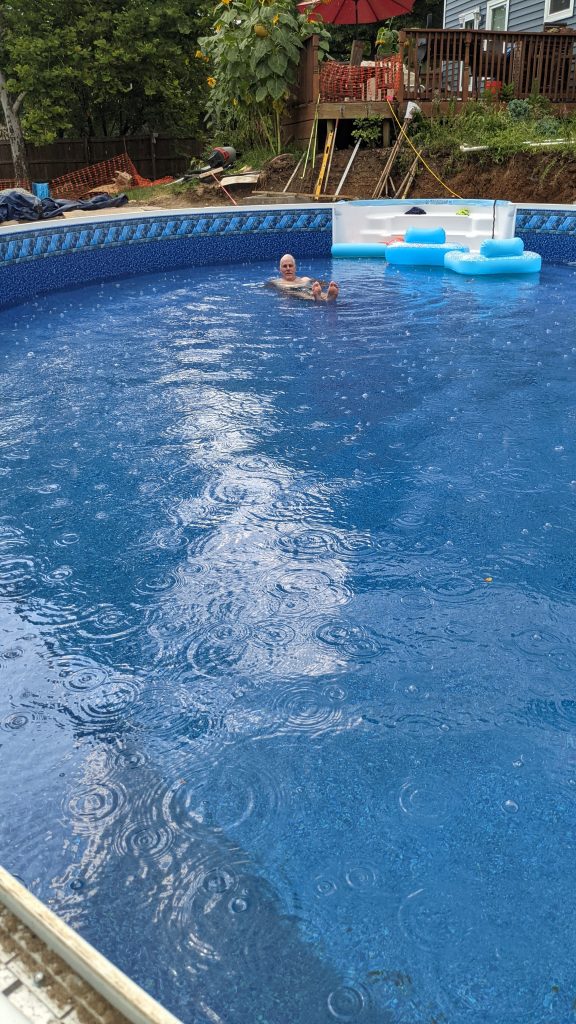

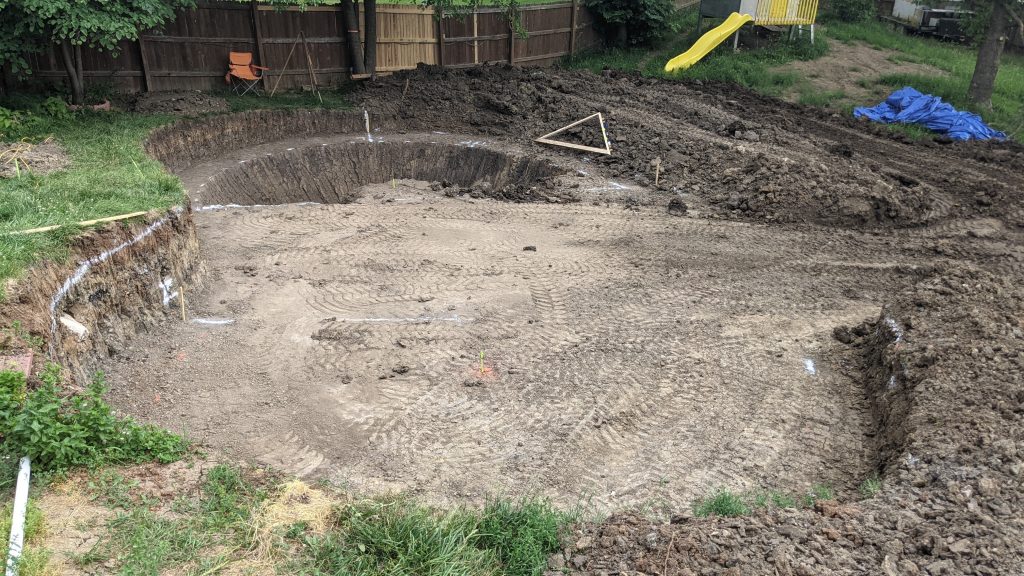

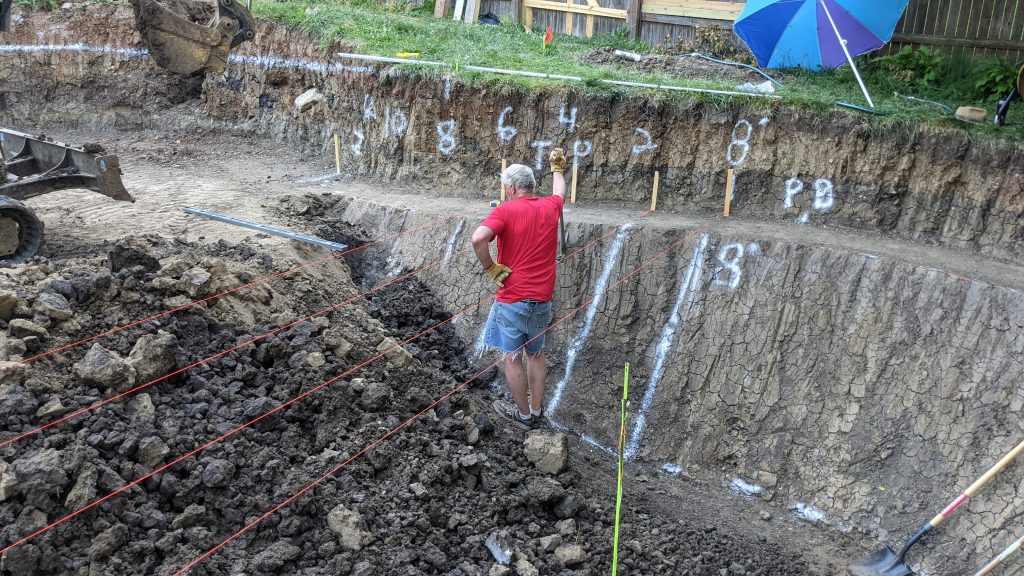

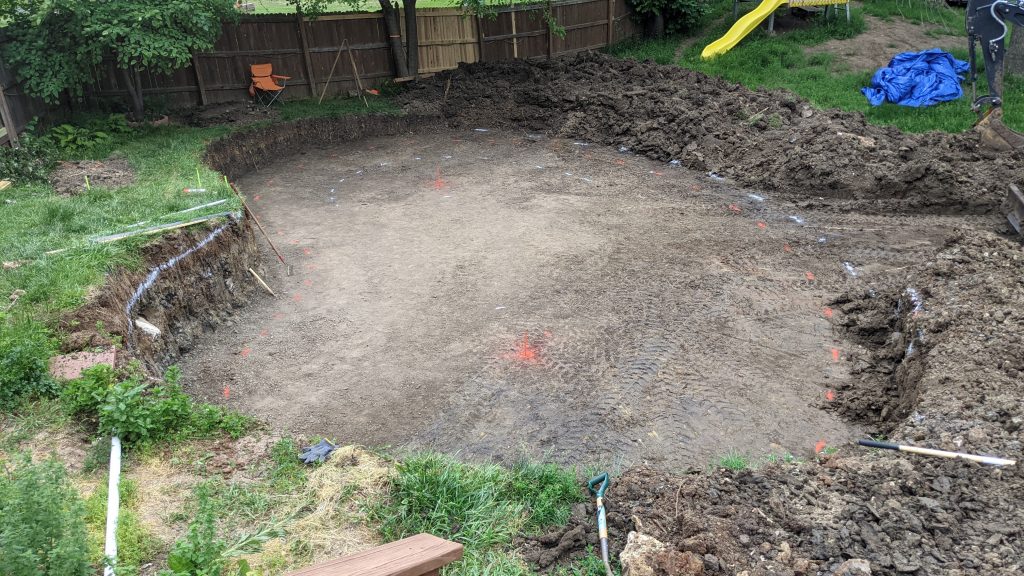

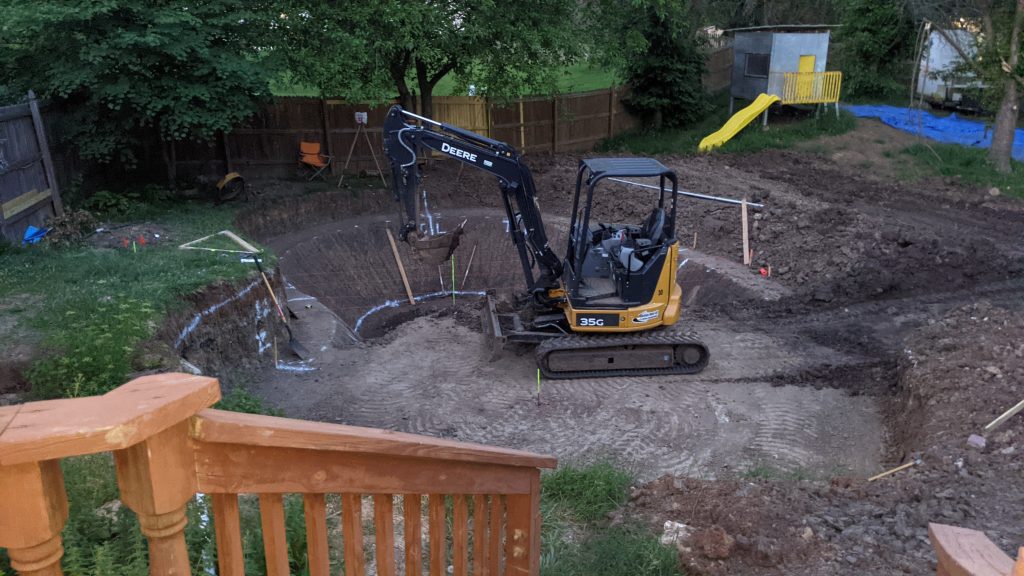

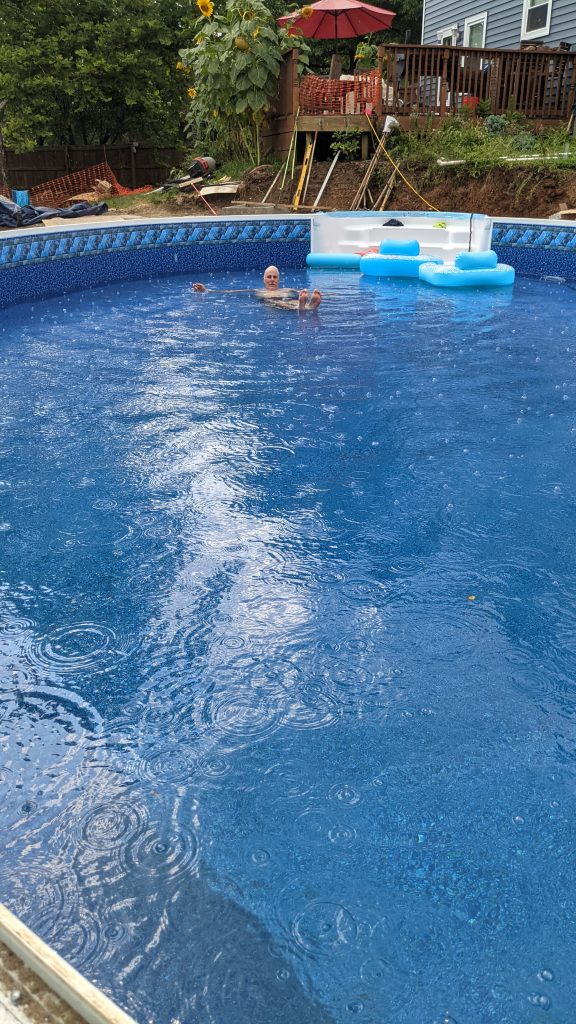

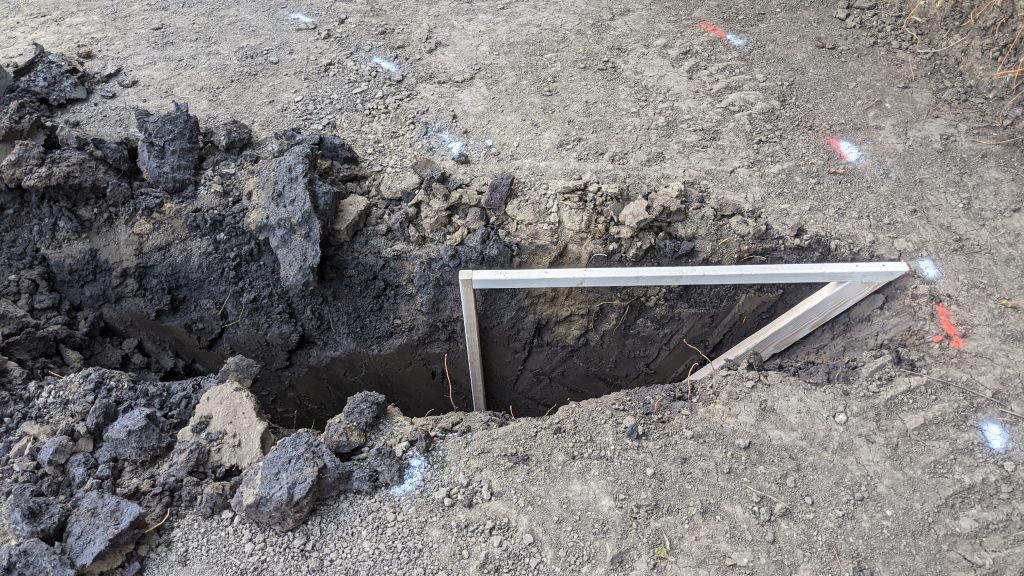

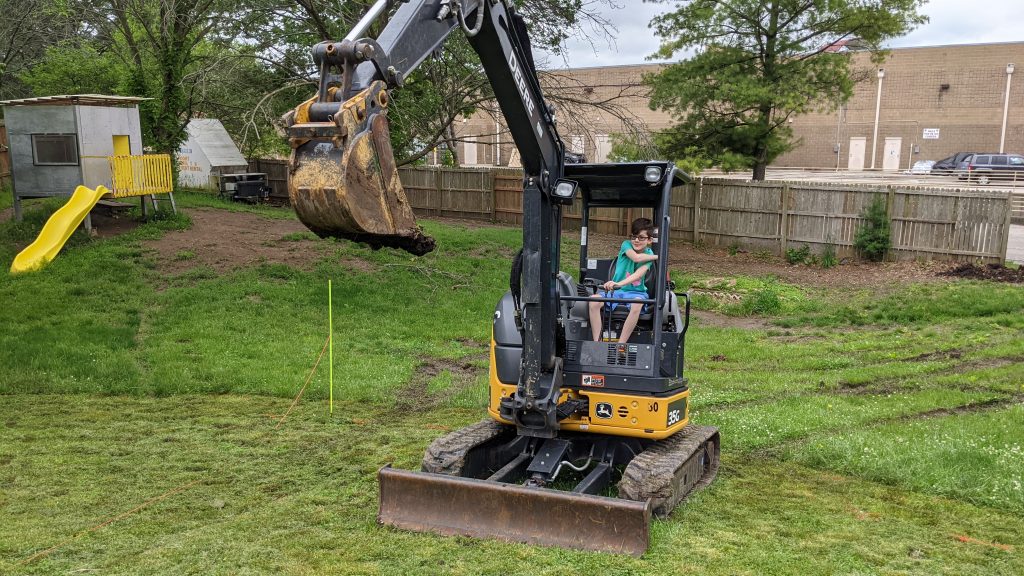

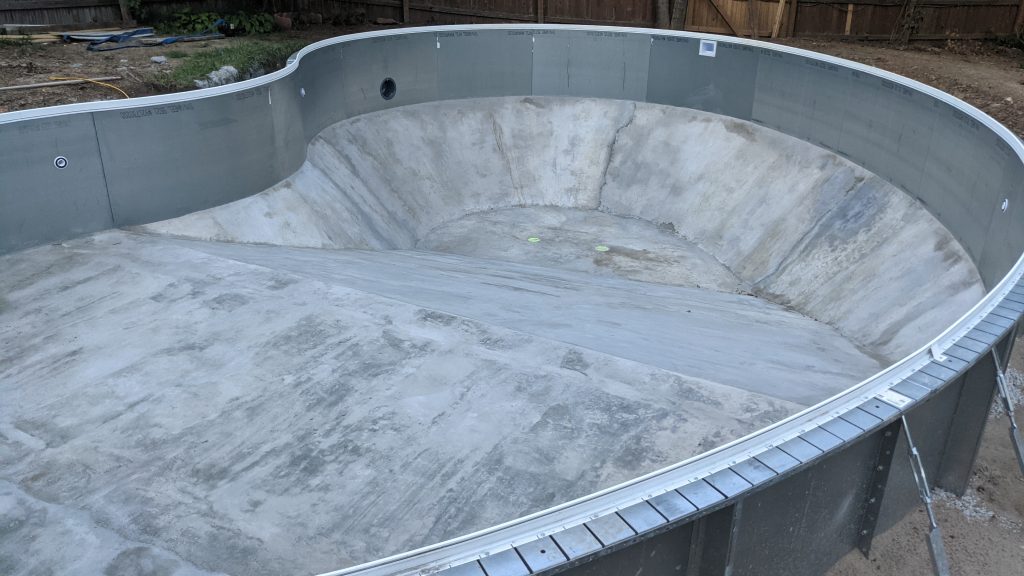

We broke ground on 5/18 and completed the panel shelf (shallow depth) on 6/6.Completed the deep end (hopper) on 6/13.Ramp completed 6/22.Panels and entry steps completed 7/8.Footer pour completed 7/13.Pool base pour completed 7/23.Liner installed 7/27. Pool was filled and fully functional by 8/6.
